interior walls
Hello readers,
after a long time again a little update.

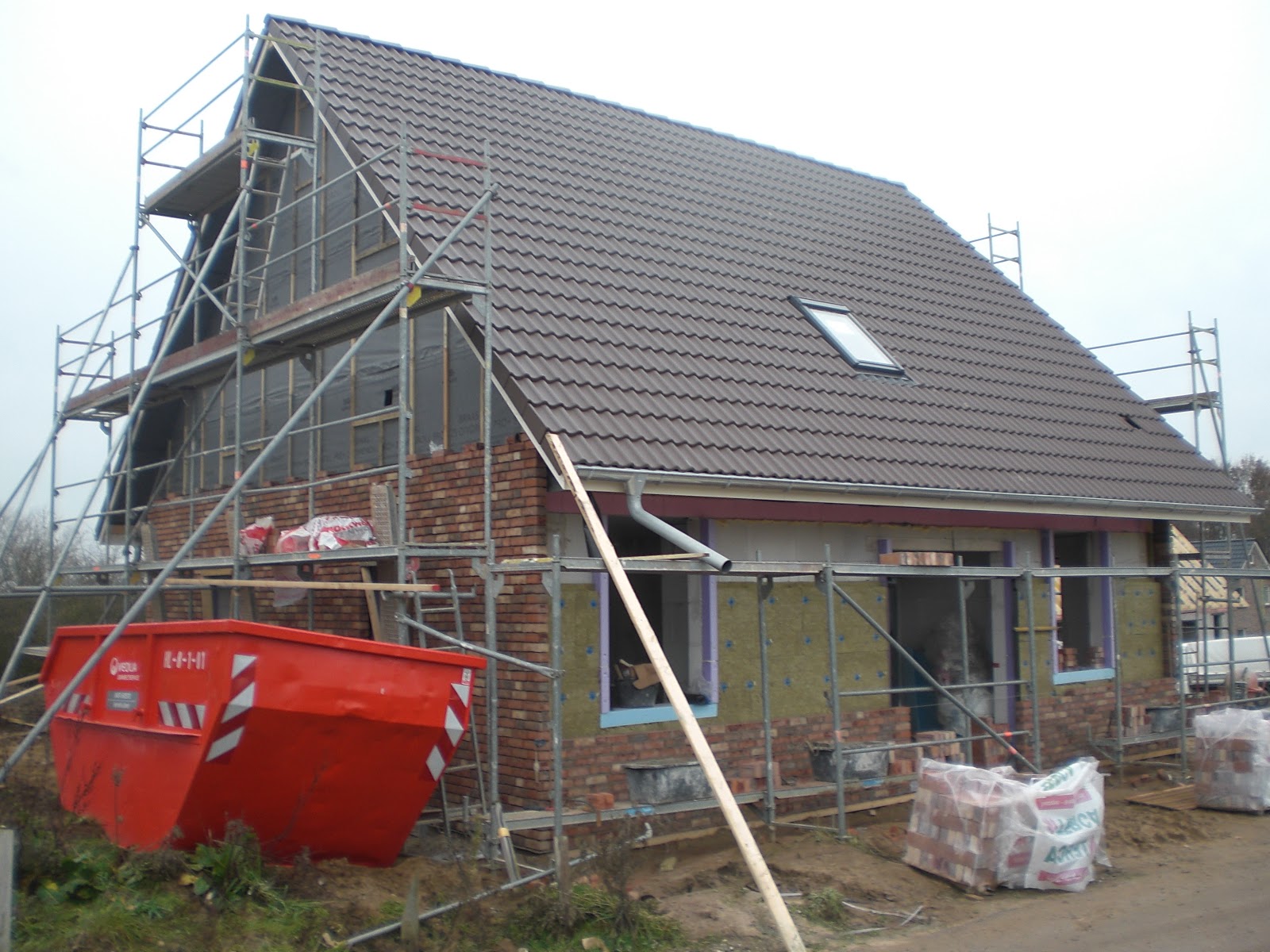

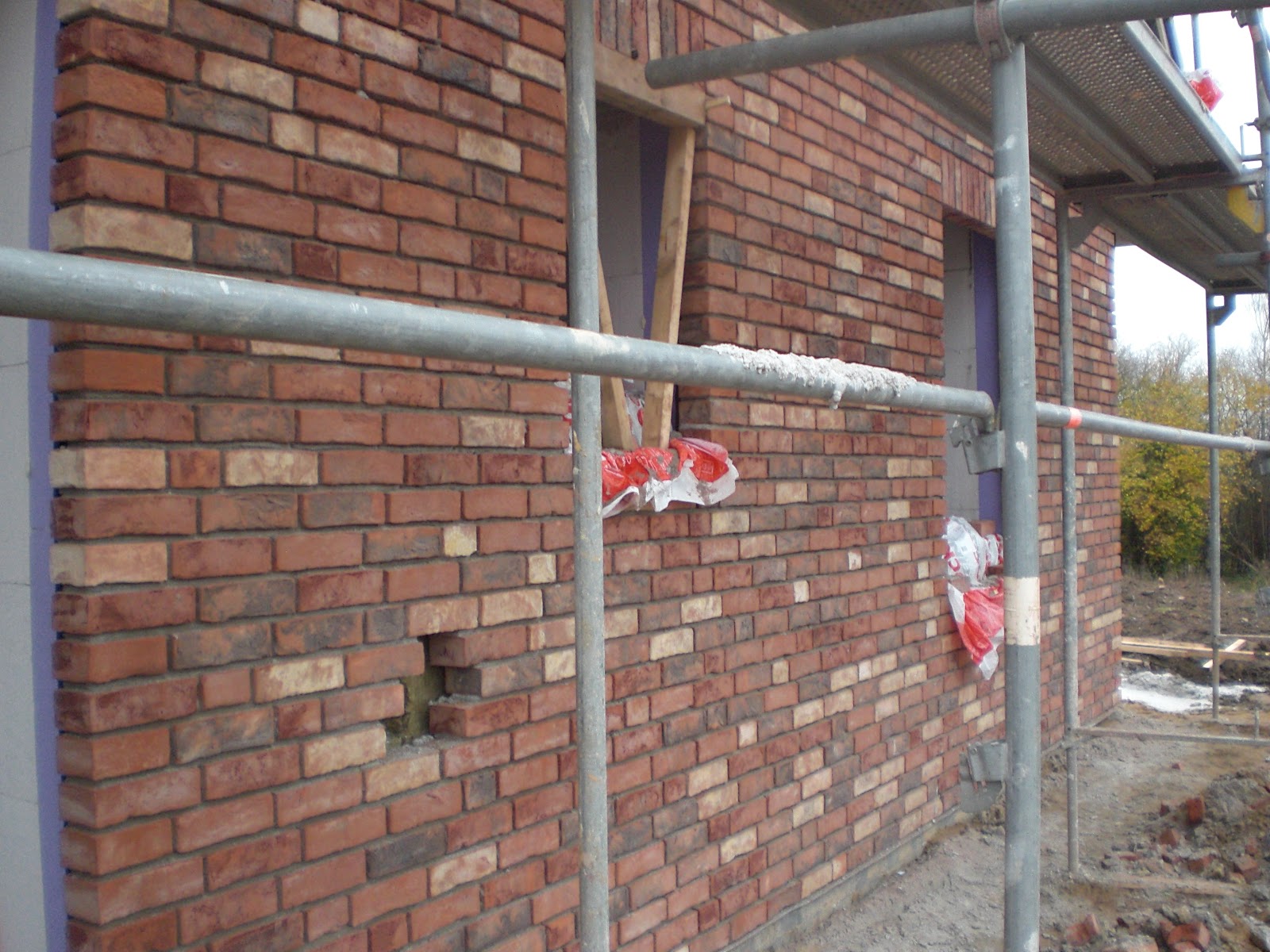

During the past week, the builders of J & S Construction in the freezing cold Verblendarbeiten completed ... at least almost. When we were on Saturday at the site, for 10-15 series have been missing in a gable. I guess that they both went on Friday for the weekend. In the cold and not to blame.
According to our construction schedule in the last week should include the interior walls on the first floor masonry be. These, but nothing was visible. Our construction manager has given us schonmal Mr. Koop warned that with the current temperatures can not be assured that will continue. I went down again today after work at a venture to the site and was pleasantly surprised. The gable is now completely blind and the inside walls of the floor are completely finished. The guys were really busy today ... super!
The plan will come next week, the windows and exterior doors. Whether that happens in the cold can not yet say. It probably is a risk that the window is then forgiven. We have to hope that we in the next few days again higher Temperatures get.
followed by pictures ...
Monday, November 29, 2010
Saturday, November 27, 2010
Do Female Like Vegina Hair
screed is preheating
Our floor is now heated up about 2 weeks, then can be tiled.
electricity and gas consumption are now at our expense ;-(
The onset of winter can currently can not work outside of the house again so I hope we do not get a record-breaking winter like last year ...
Our floor is now heated up about 2 weeks, then can be tiled.
electricity and gas consumption are now at our expense ;-(
The onset of winter can currently can not work outside of the house again so I hope we do not get a record-breaking winter like last year ...
Sunday, November 21, 2010
Razor Street Pro Scooter Melbourne
floor drywall I
Hello readers,
in the last week is not so much has happened with us. The masons were at a different site. According to construction schedule so they should start in week 46 for us with the Verblendarbeiten with us. Because on another site but no stones have been delivered, they have just already in week 45 and started with us now make in week 47 (hopefully) more. However
have finished the drywall carpenters I.

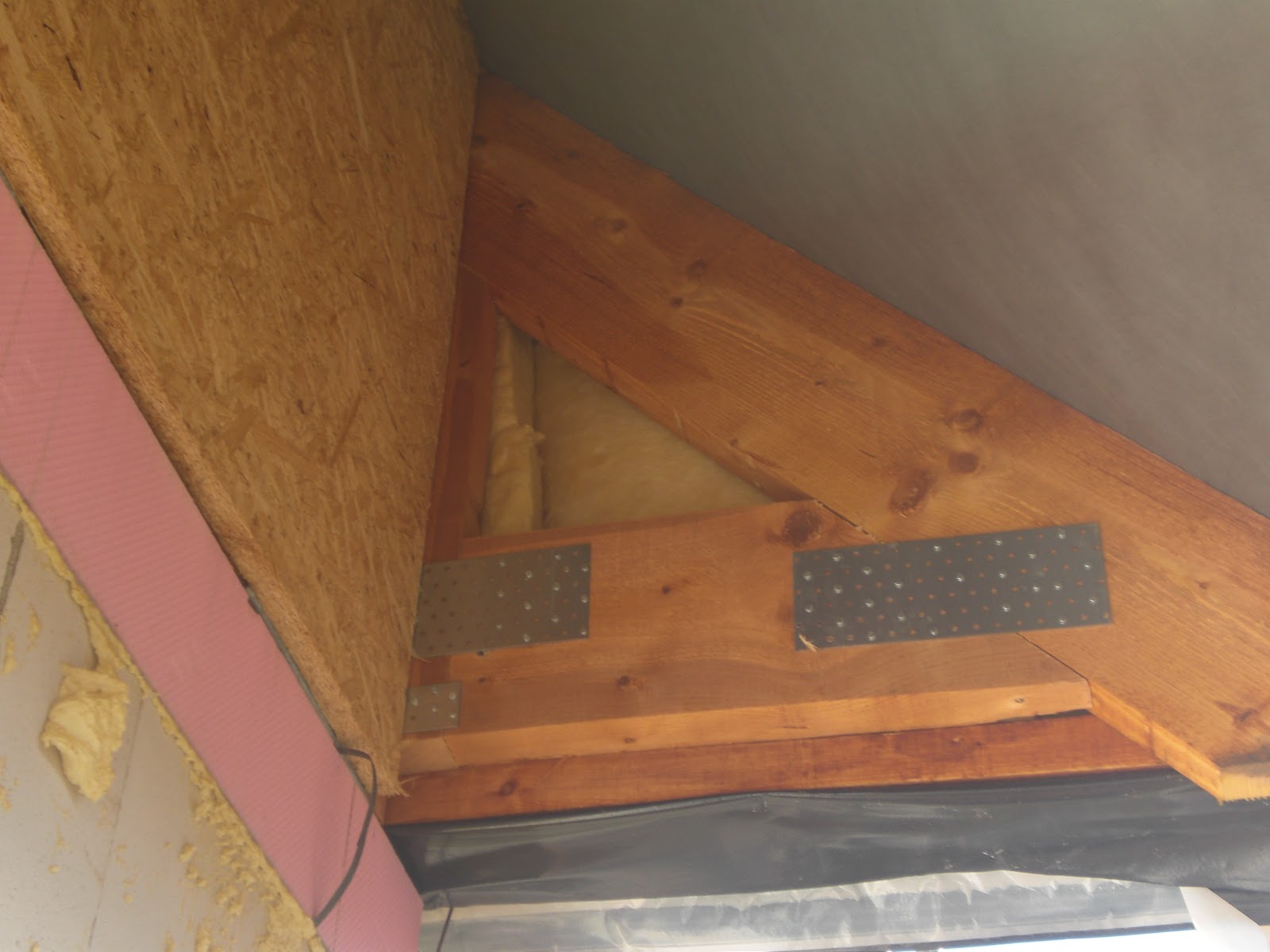

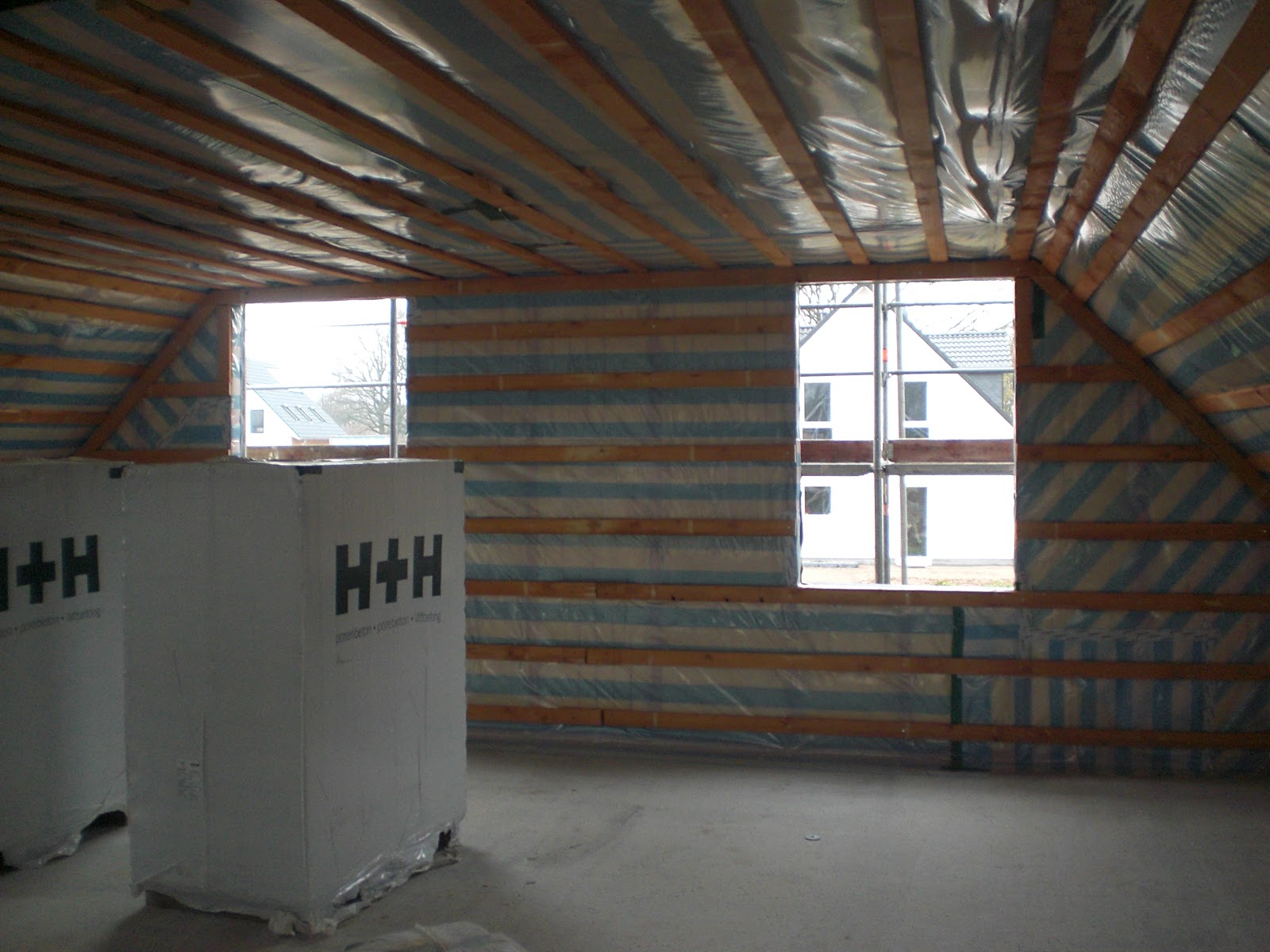

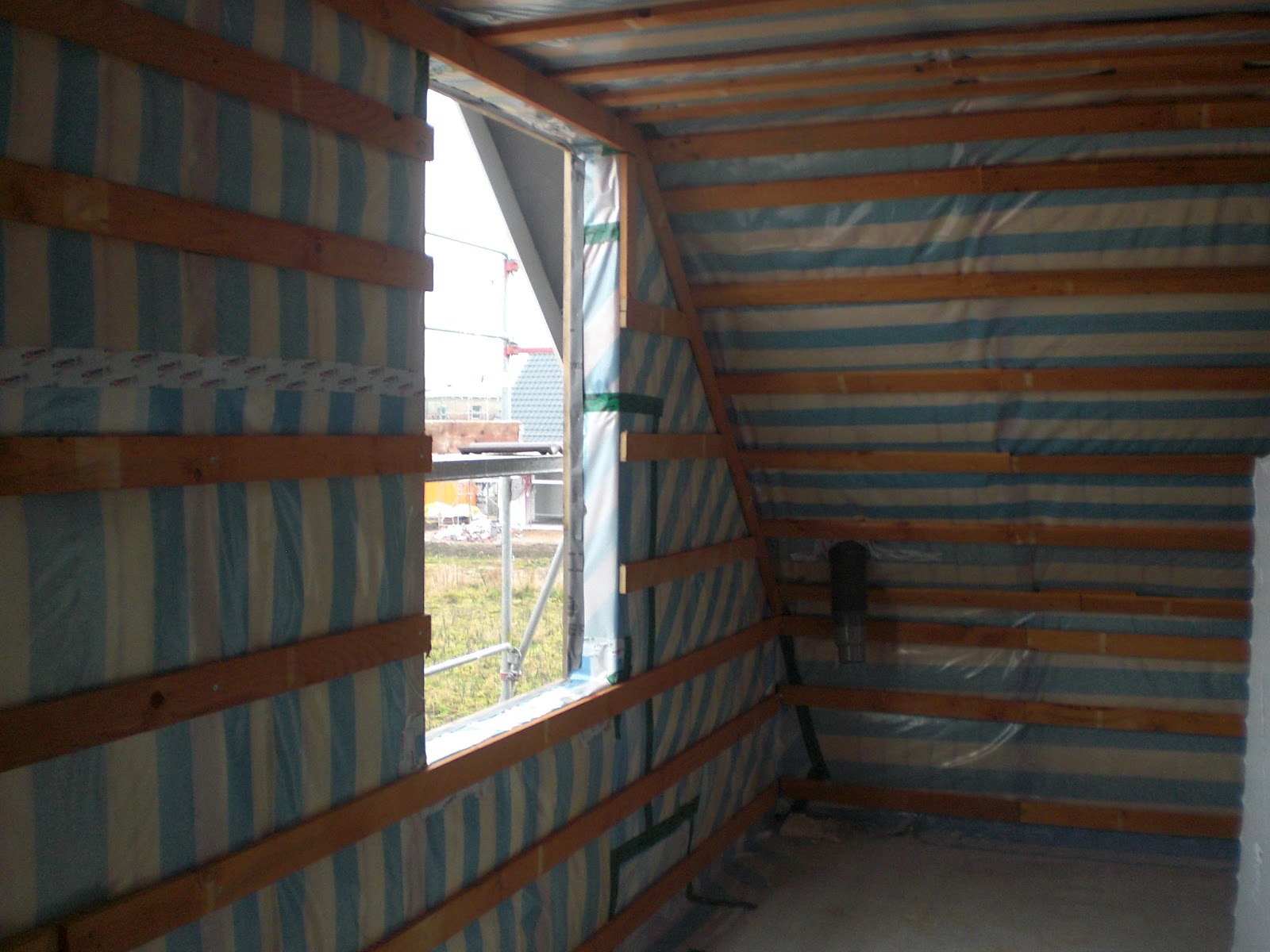

Upstairs the vapor barrier sheet and the batten was installed. This looks quite good so far. I was looking for small cracks at the weekend and have found nothing. Also you were so nice and made our OSB distributed in the loft. But was not quite uneigenützig, so you could move better here.
The developer has removed over the weekend, the fascia boards on the gable ends a second time. I was on the last weekend already smoothed the screw holes, ground and made the first coat. Because of the bad weather I had with the second coat now wait until this Saturday.

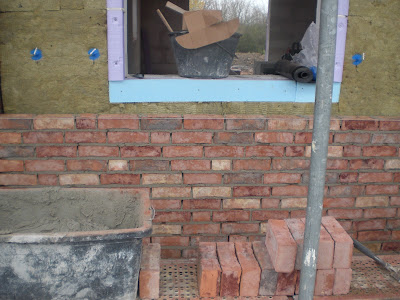

will this week finally released the interior walls are brick in the floor and if all goes well, next week, come the windows and exterior doors.
Here are some impressions:

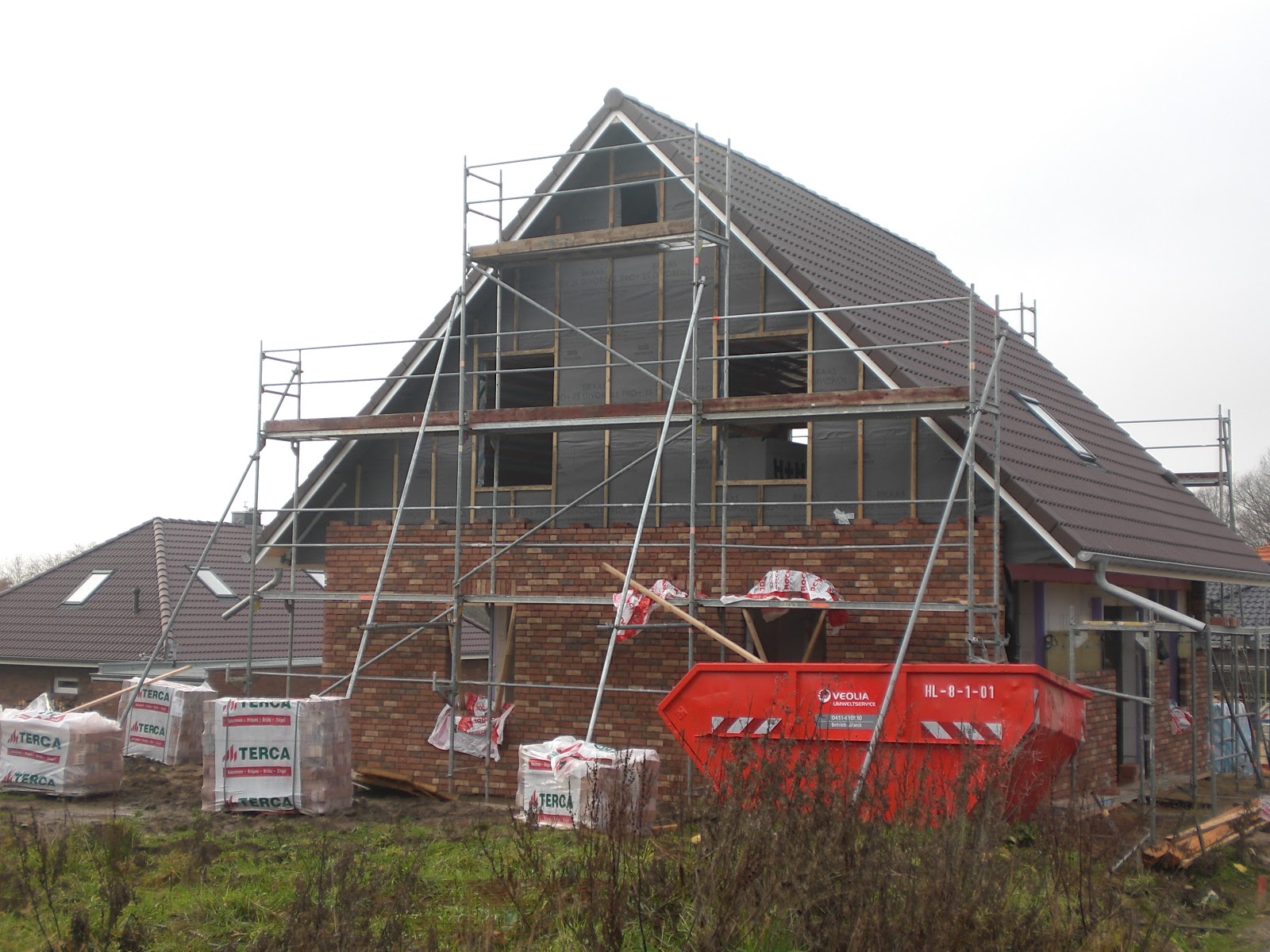

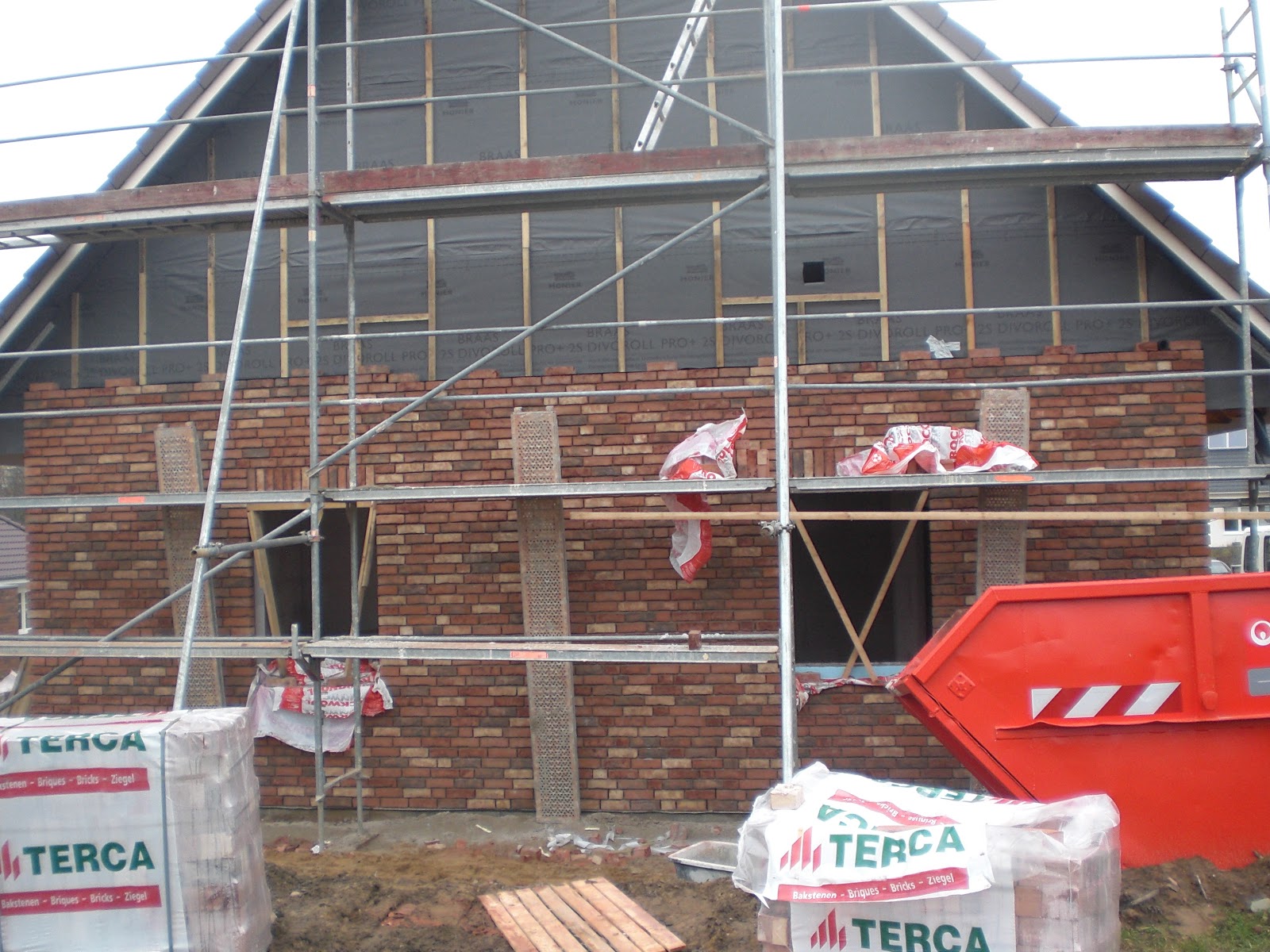

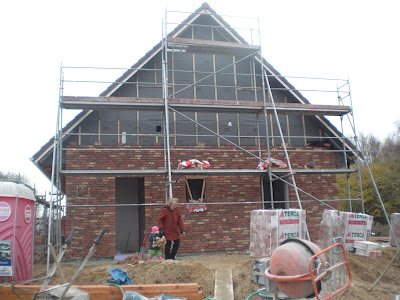

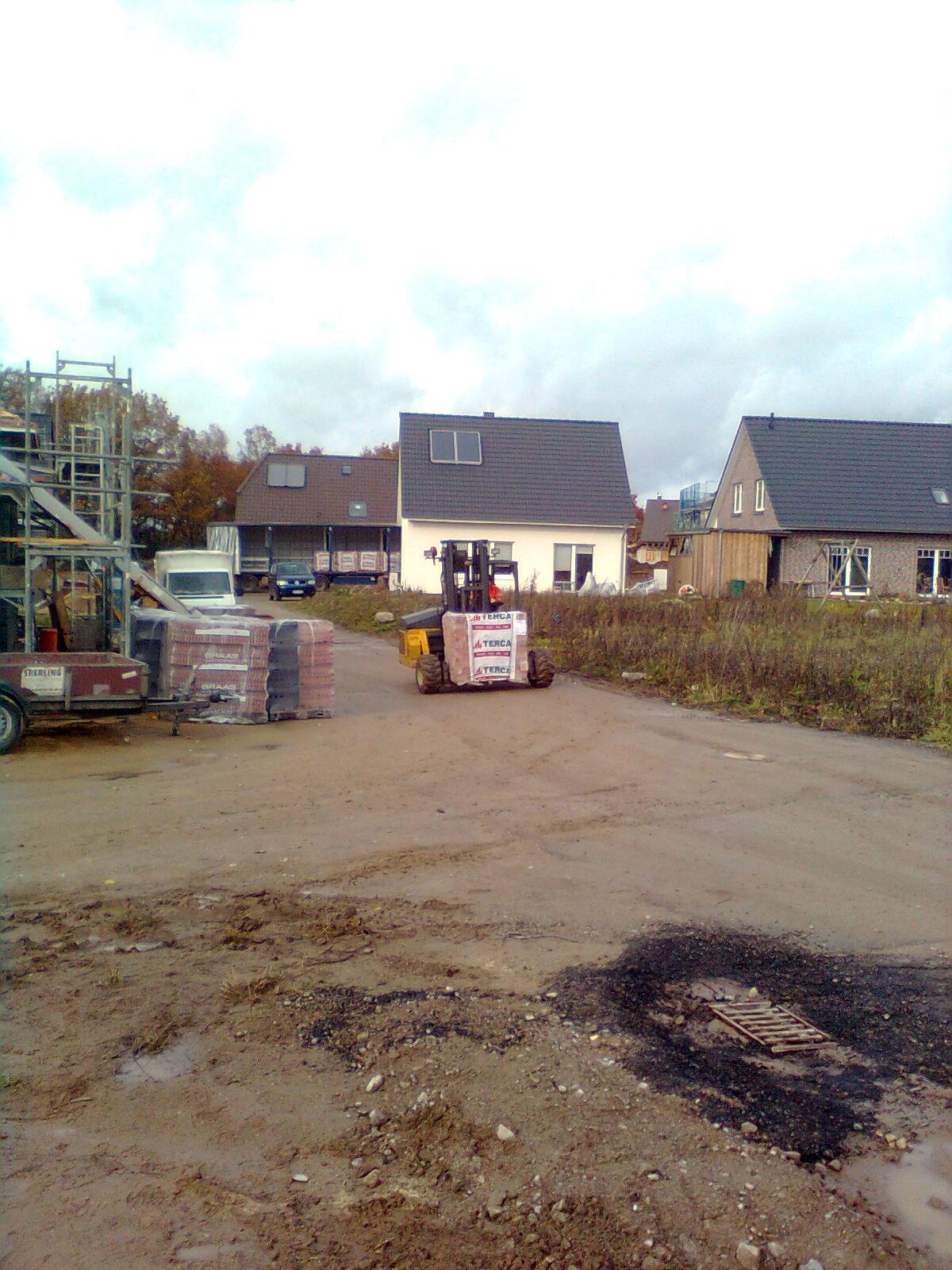

A view from the main road in the stony fields Redder on our house:
Hello readers,
in the last week is not so much has happened with us. The masons were at a different site. According to construction schedule so they should start in week 46 for us with the Verblendarbeiten with us. Because on another site but no stones have been delivered, they have just already in week 45 and started with us now make in week 47 (hopefully) more. However
have finished the drywall carpenters I.
Upstairs the vapor barrier sheet and the batten was installed. This looks quite good so far. I was looking for small cracks at the weekend and have found nothing. Also you were so nice and made our OSB distributed in the loft. But was not quite uneigenützig, so you could move better here.
The developer has removed over the weekend, the fascia boards on the gable ends a second time. I was on the last weekend already smoothed the screw holes, ground and made the first coat. Because of the bad weather I had with the second coat now wait until this Saturday.
will this week finally released the interior walls are brick in the floor and if all goes well, next week, come the windows and exterior doors.
Here are some impressions:
| |

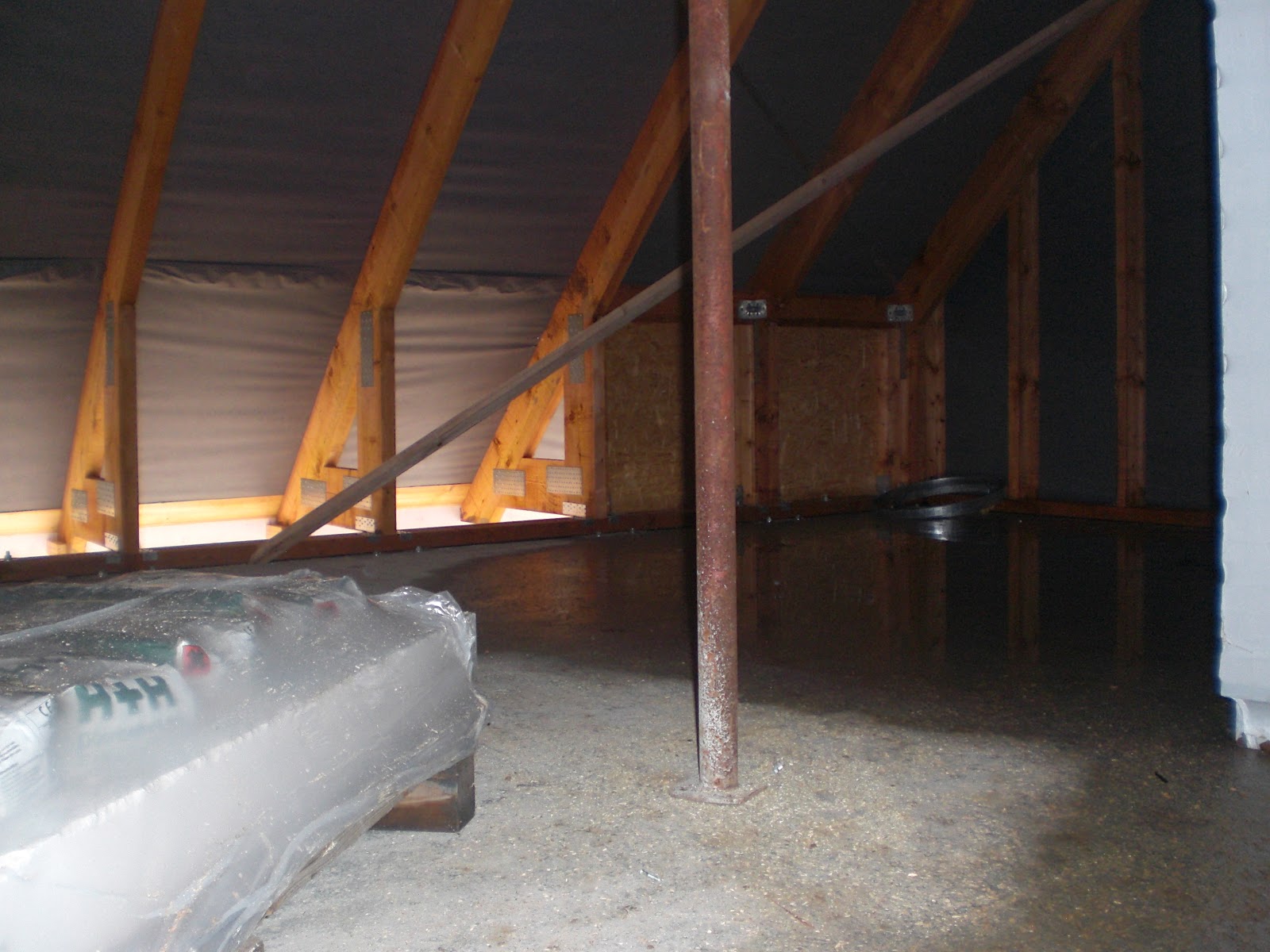

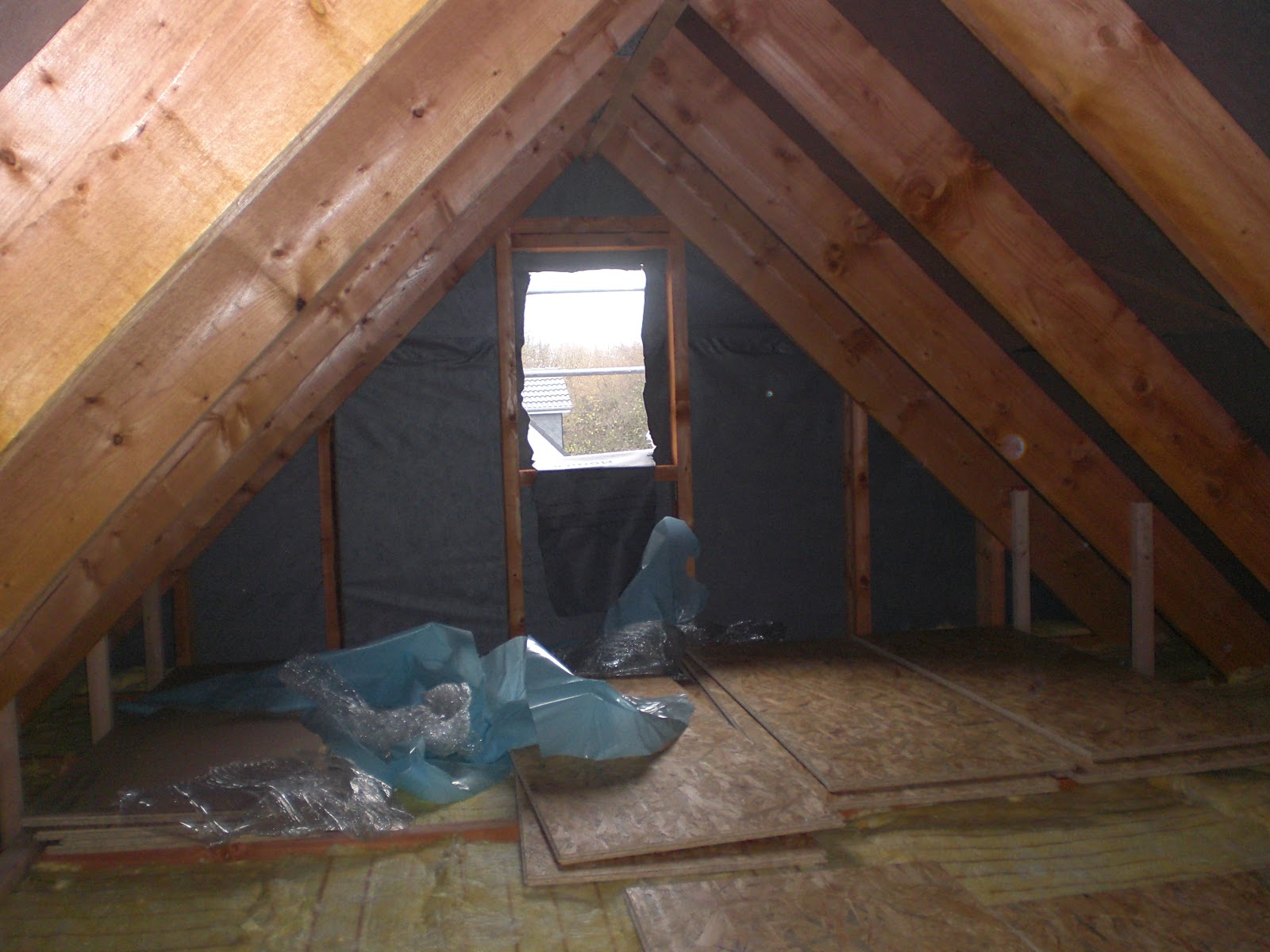

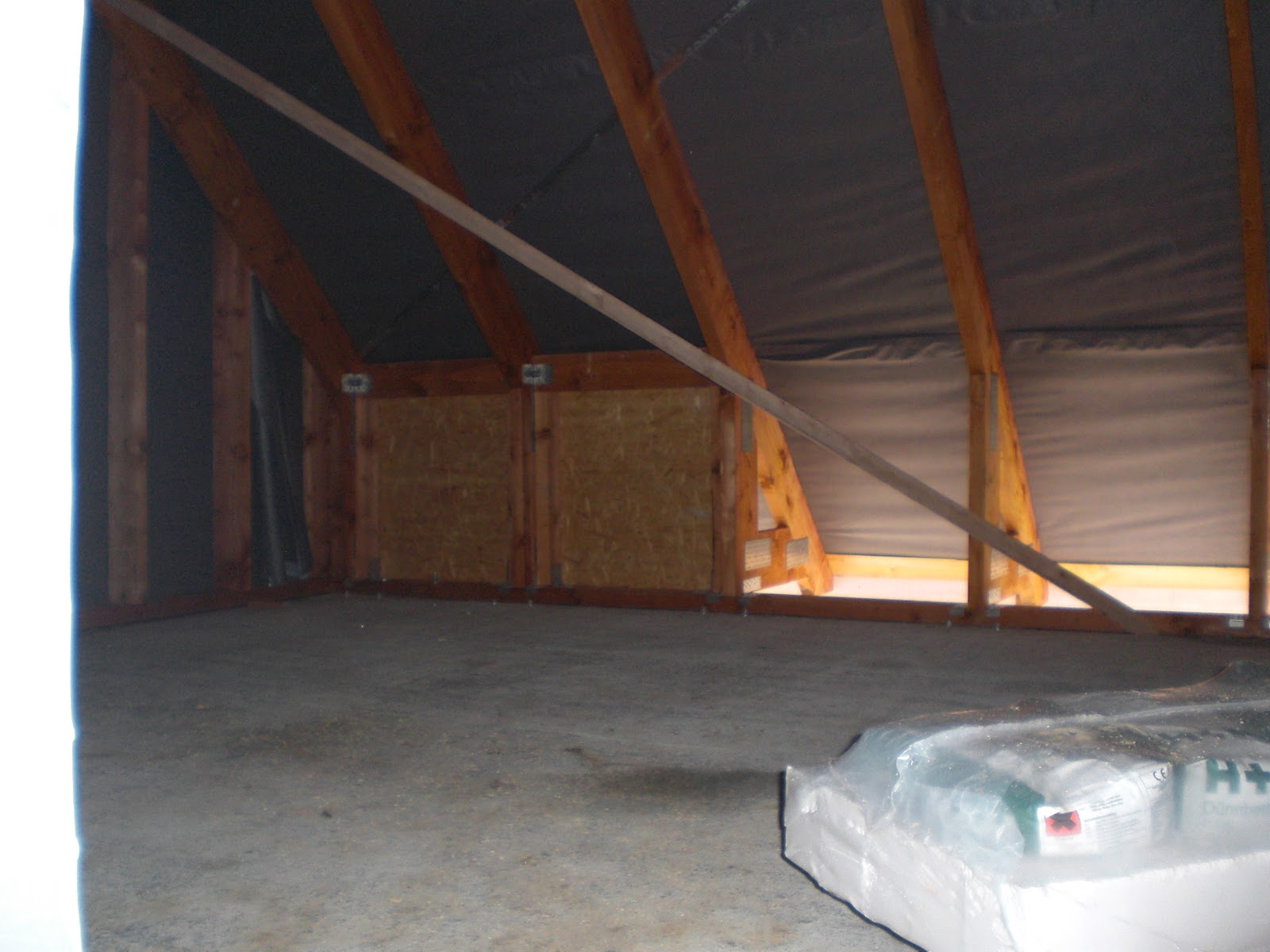

| skylight staircase |
| |

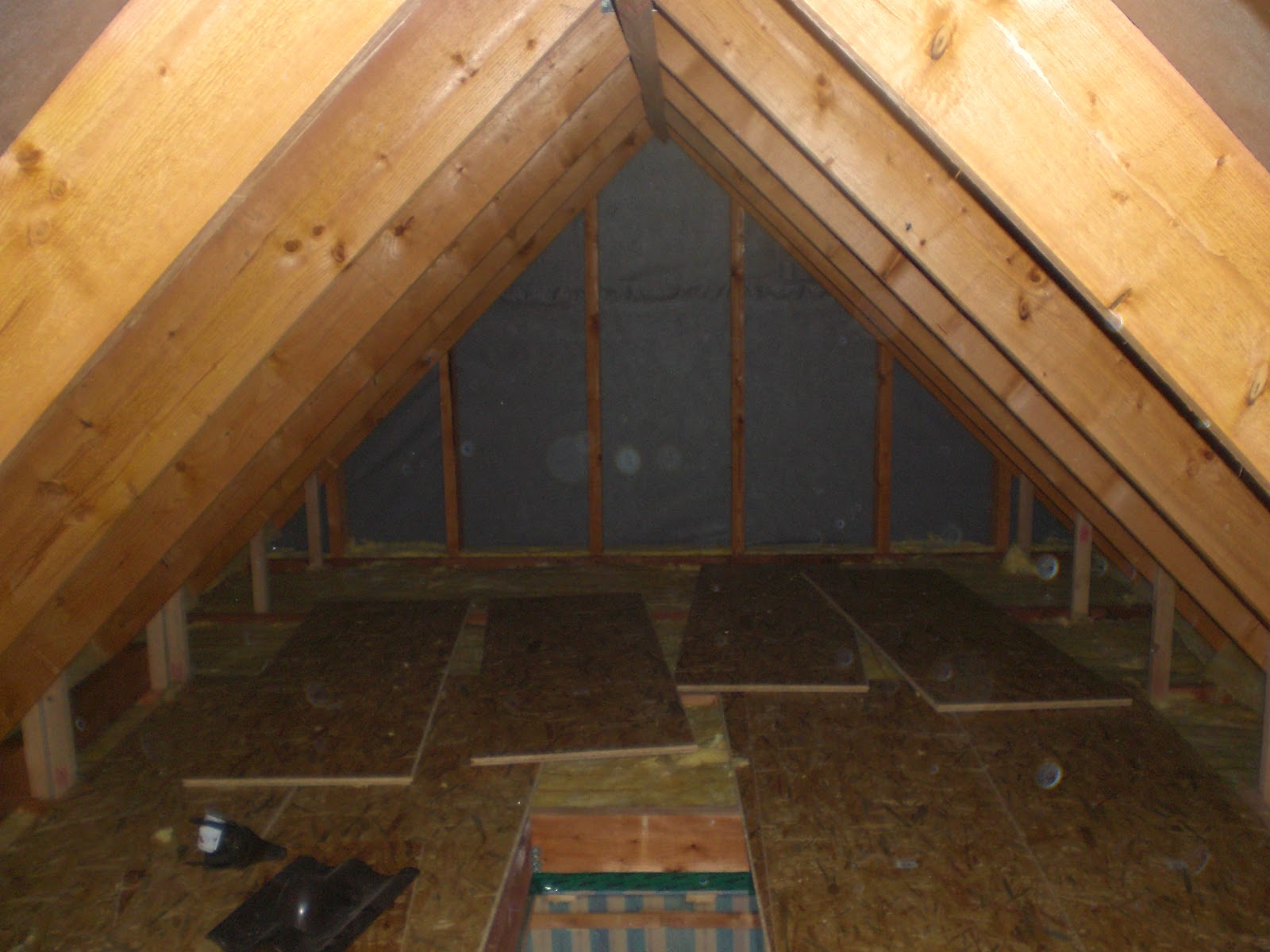

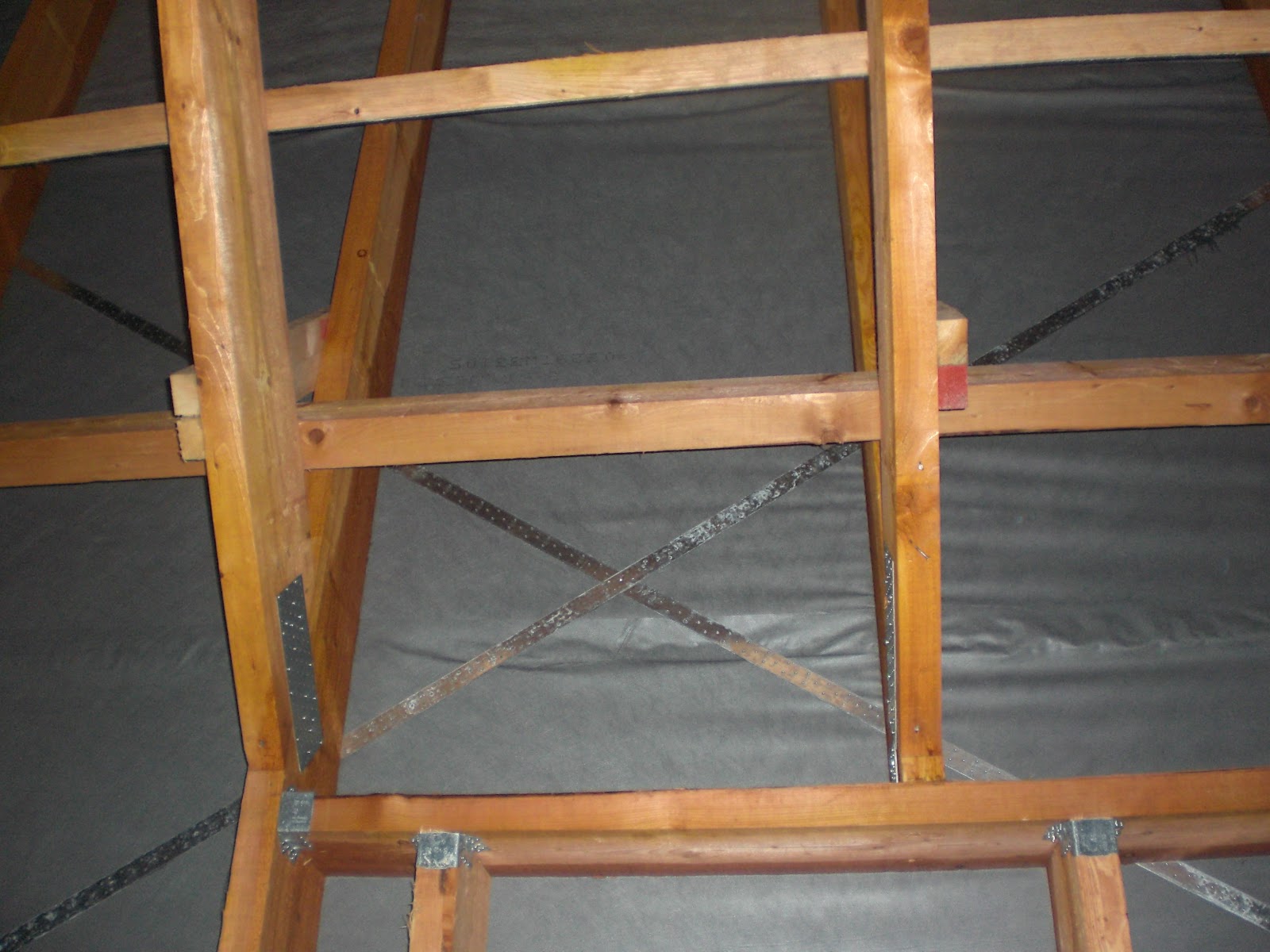

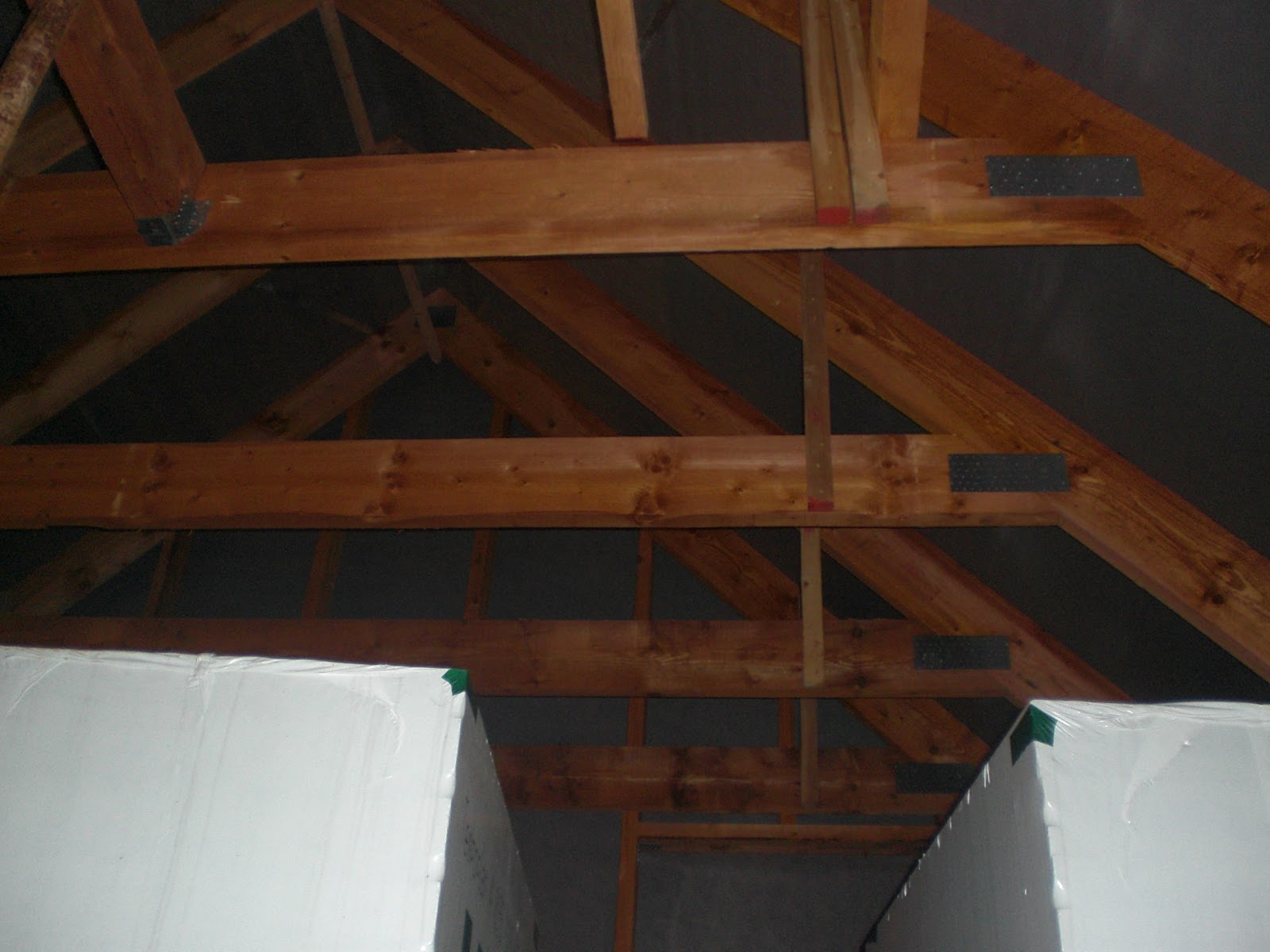

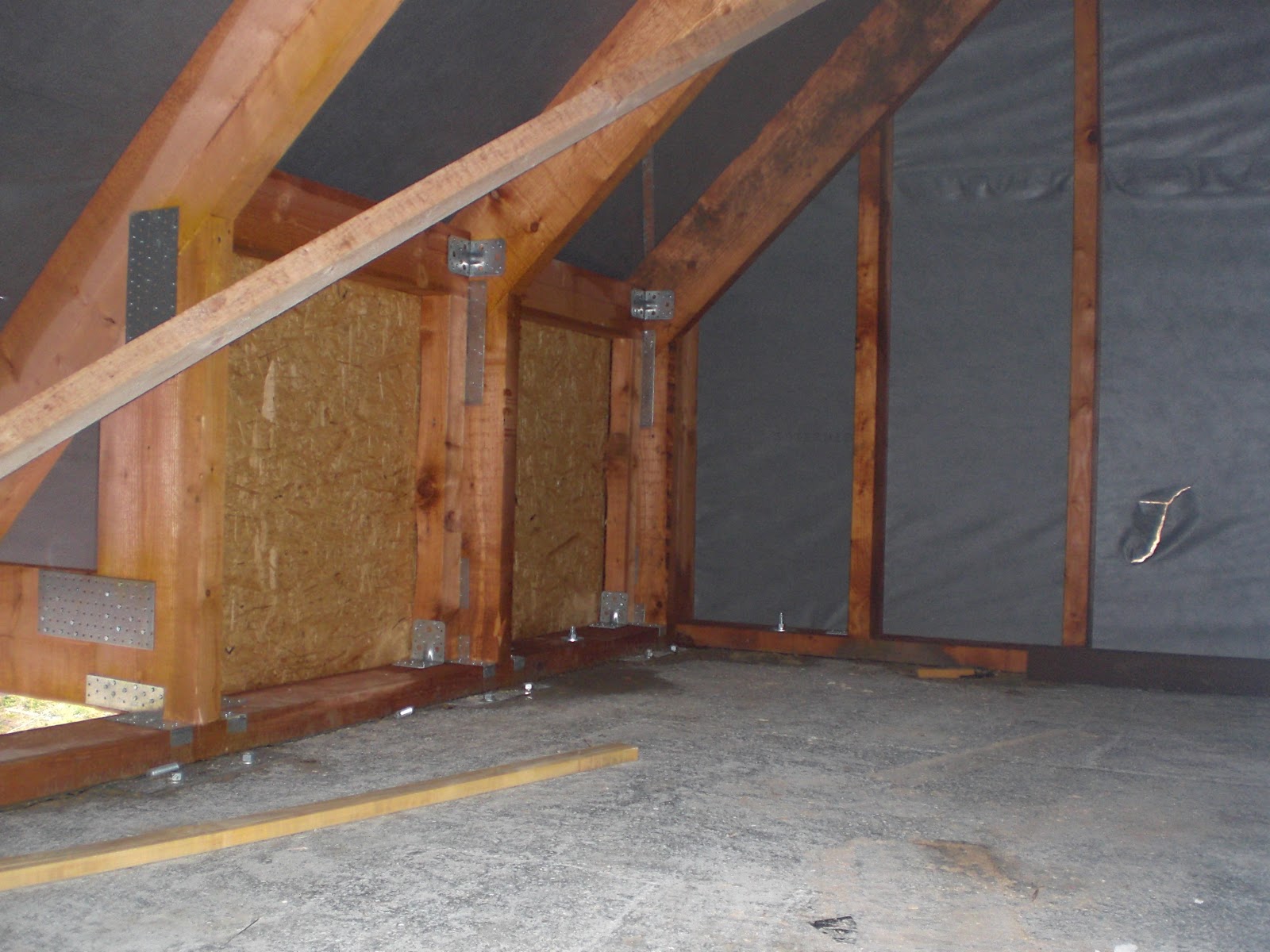

| loft west |
| |
| loft east |
| |

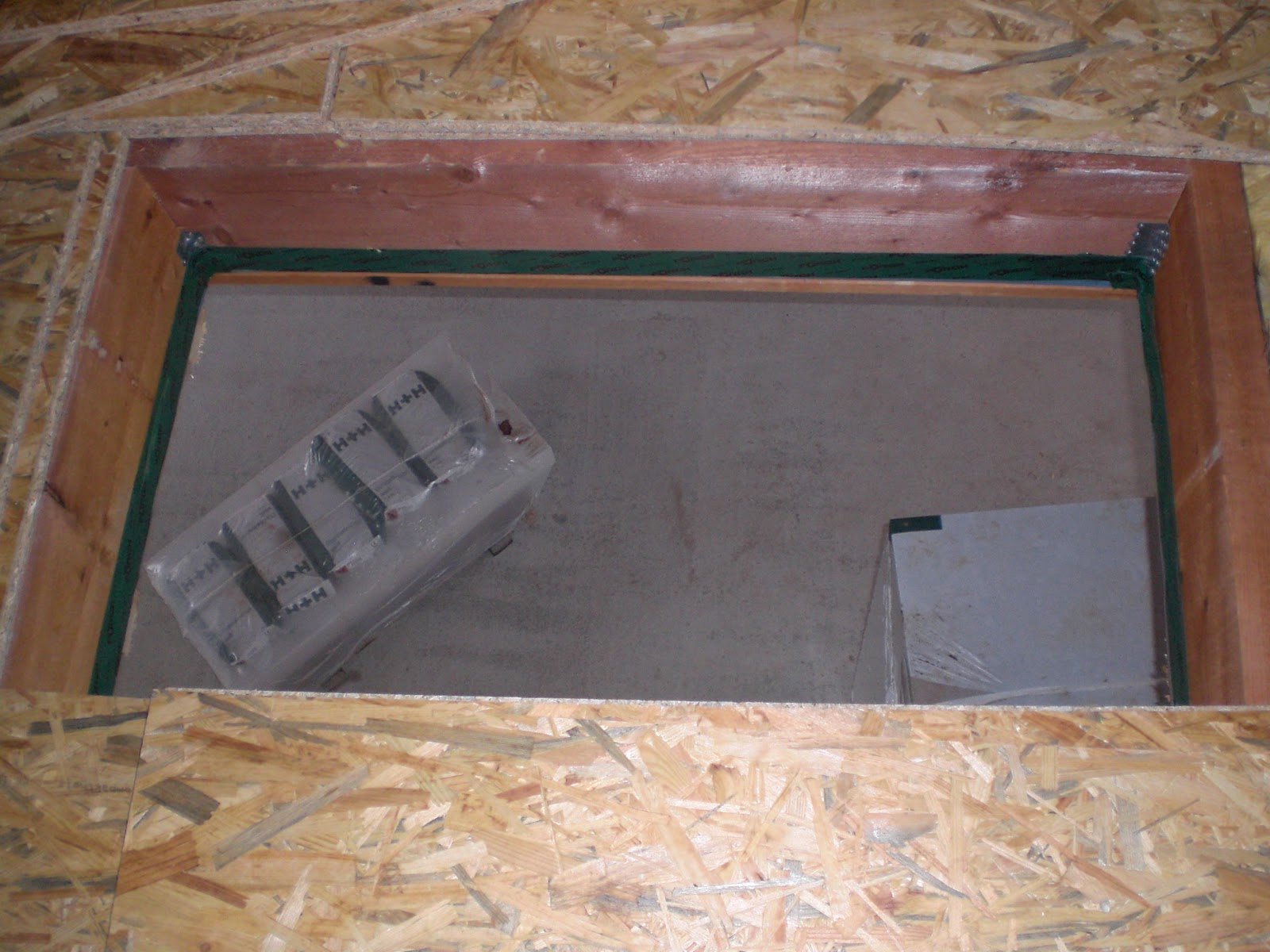

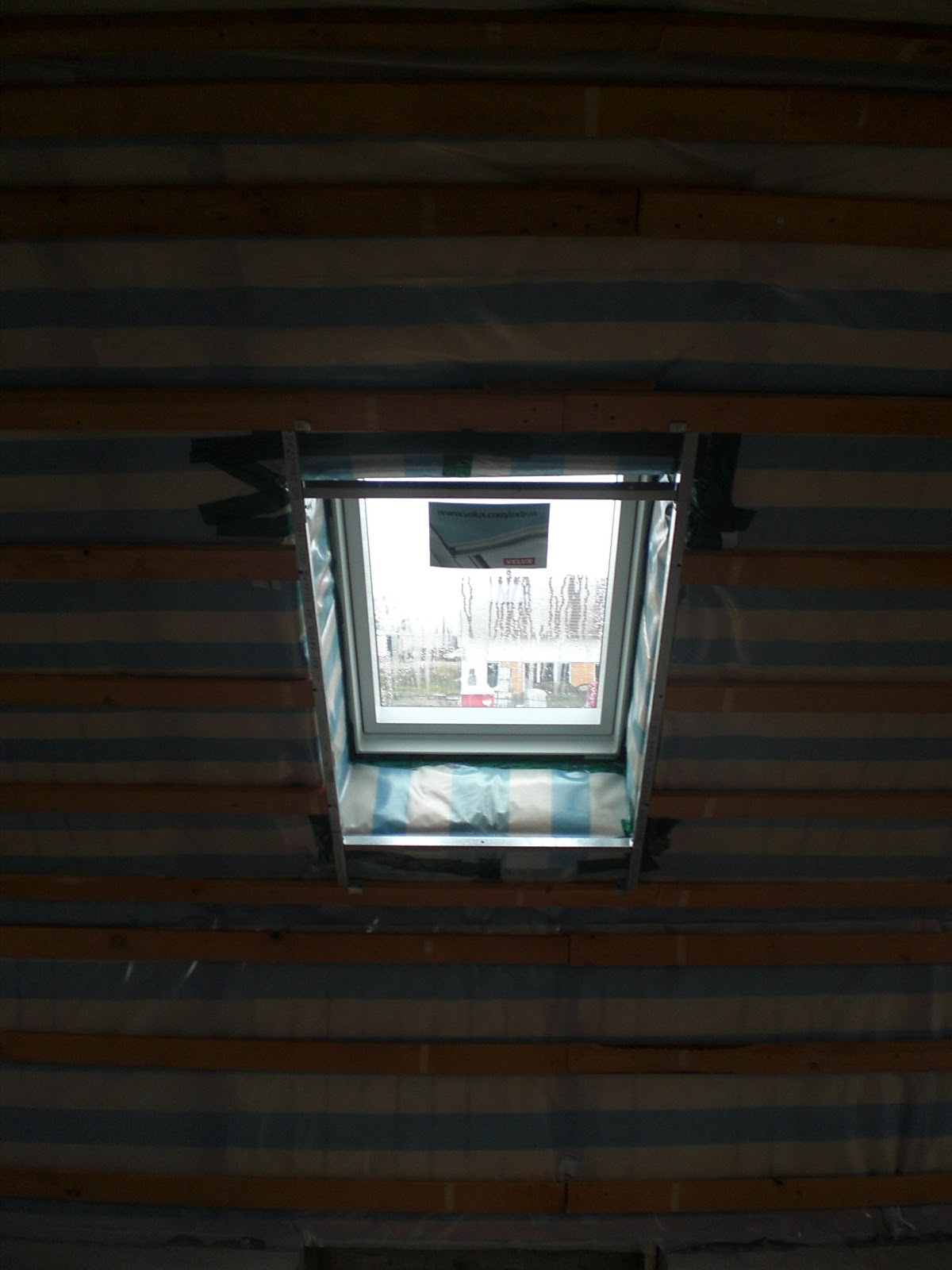

| hatch |
| |
| roof vent in the bathroom |
| |
| Nursery 1 u.2 |
| |
| east |
| |
| west |
Thursday, November 18, 2010
Electric Box Level 18 Iphone
Soon it warm
little of the last couple days.
little of the last couple days.
- In own performance, we have two walls in the HWR removed before the gas heater is positioned against the wall and had to determine that this is super simple "Malschwamm" (known from TV advertising) is completely useless ...
- Mr. Schneider get a picture sent from the future of our fall protection. The execution will be with frosted glass.
- allowance has been made of the kitchen - All the walls are so long / broad been as planned. The proposed kitchen will soon go into production and will be delivered around mid January.
| |

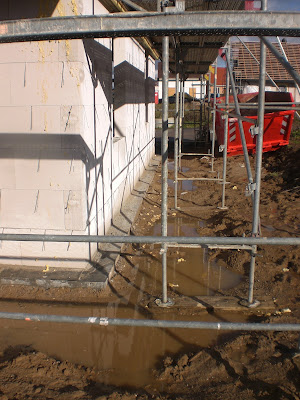

| fall protection |
- The tiler has coordinated with the heating engineers and schedules its work before Christmas or early January.
- The gas heater was laced before and is under construction - the heating program started this year or early next week and will last 11 days.
| |
| Rear View Therme |
- The ventilation system will be delivered tomorrow and possibly mounted.
- allowance of the carpet on the floor was also made. We have chosen a way of Vorwerk carpet in dark charcoal gray. Just learn ::
Monday, November 15, 2010
Dawn De Pokemon Doujin
No DSL in Ilten
Edit "The expansion will LTE (in Hanover) by Vodafone, Deutsche Telekom and O2 co-driven by distinct parts of the city / region.."
LTE (Long Thermal Evolution) is the successor to UMTS and will provide 50-100Mbit. From the end of 2010 it will available in removed locations be, while villages have \u0026lt;5000 inhabitants Prio 1 :-)
LTE Availability Check Telekom
----------------------------- ---------------------------
reference to the following postal from 26.10.2010:
On 01/11/2010, the city invited the Sehnde citizen at the town hall to the information evening regarding the DSL supply. I was not there for professional reasons and I get down standing figures reported by neighbors (I hope I give it back correctly)
It turned out summarized below Annoyances:
the moment is wait for it and drink tea and This page inform " DSL communication needs " that you need DSL.
Until we might someday get real DSL, we will probably use the UMTS / HSDPA flat rate of O2. Which is cheaper and faster than supply wireless DSL.
Edit "The expansion will LTE (in Hanover) by Vodafone, Deutsche Telekom and O2 co-driven by distinct parts of the city / region.."
LTE (Long Thermal Evolution) is the successor to UMTS and will provide 50-100Mbit. From the end of 2010 it will available in removed locations be, while villages have \u0026lt;5000 inhabitants Prio 1 :-)
LTE Availability Check Telekom
----------------------------- ---------------------------
reference to the following postal from 26.10.2010:
On 01/11/2010, the city invited the Sehnde citizen at the town hall to the information evening regarding the DSL supply. I was not there for professional reasons and I get down standing figures reported by neighbors (I hope I give it back correctly)
It turned out summarized below Annoyances:
- The city has Sehnde slept through certain contracts / agreements with Telekom and can not be anything written ....
- are missing as of today about 7000 € for a DSL supply for the construction area, which of course may not be paid from any funds can / and the coffers of the city are empty anyway
- lie in the soil already includes fiber optic cables like VDSL, somewhere Sehnde / environment would have to our local distribution box will be expanded
- Telekom refuses the construction area with DSL supply because the cost will not be recouped in the foreseeable future, since most "customers" would sign with alternative providers, the contracts ;
- We need to establish an association with negotiate the Telekom DSL supply of the construction area and the club (or we) may be the cost of 7000 € and higher pay
- Some of the construction area have said that they do not participate in it
- argument of the city: DSL is available on radio
- wireless DSL is slow and expensive, also did not own the most pleasant impression, "I'm not dependent on you" - the Thank You! * Ironic *
the moment is wait for it and drink tea and This page inform " DSL communication needs " that you need DSL.
Until we might someday get real DSL, we will probably use the UMTS / HSDPA flat rate of O2. Which is cheaper and faster than supply wireless DSL.
Thursday, November 11, 2010
Birthday Poems Asking For Money As Gifts
facing (not Stieg Larsson)
Hello readers,
since it is always already dark when the owner comes home, was the building owner today to make the site a few photos. This we do not, of course, before you mentioned:
The Erdsondenbohrung was unfortunately not done because the drill site allegedly was not accessible. Why have we not previously informed me that remains a mystery. Well, a different date to follow shortly.
Hello readers,
since it is always already dark when the owner comes home, was the building owner today to make the site a few photos. This we do not, of course, before you mentioned:
| |
| mother-and Hannah |
The Erdsondenbohrung was unfortunately not done because the drill site allegedly was not accessible. Why have we not previously informed me that remains a mystery. Well, a different date to follow shortly.
Tuesday, November 9, 2010
Dunking Machine Singapore Rental
Moving ahead ...
Hello readers,

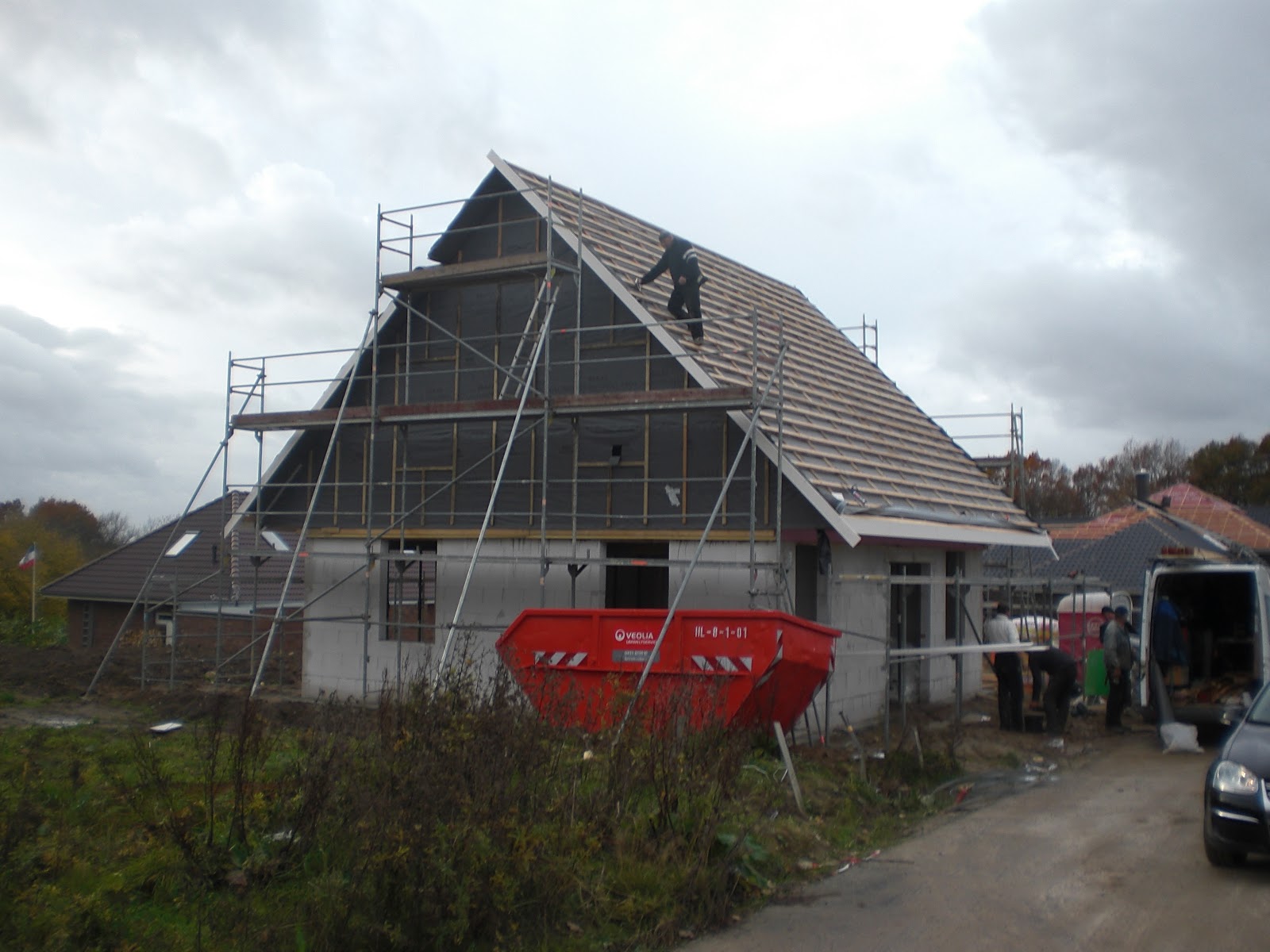

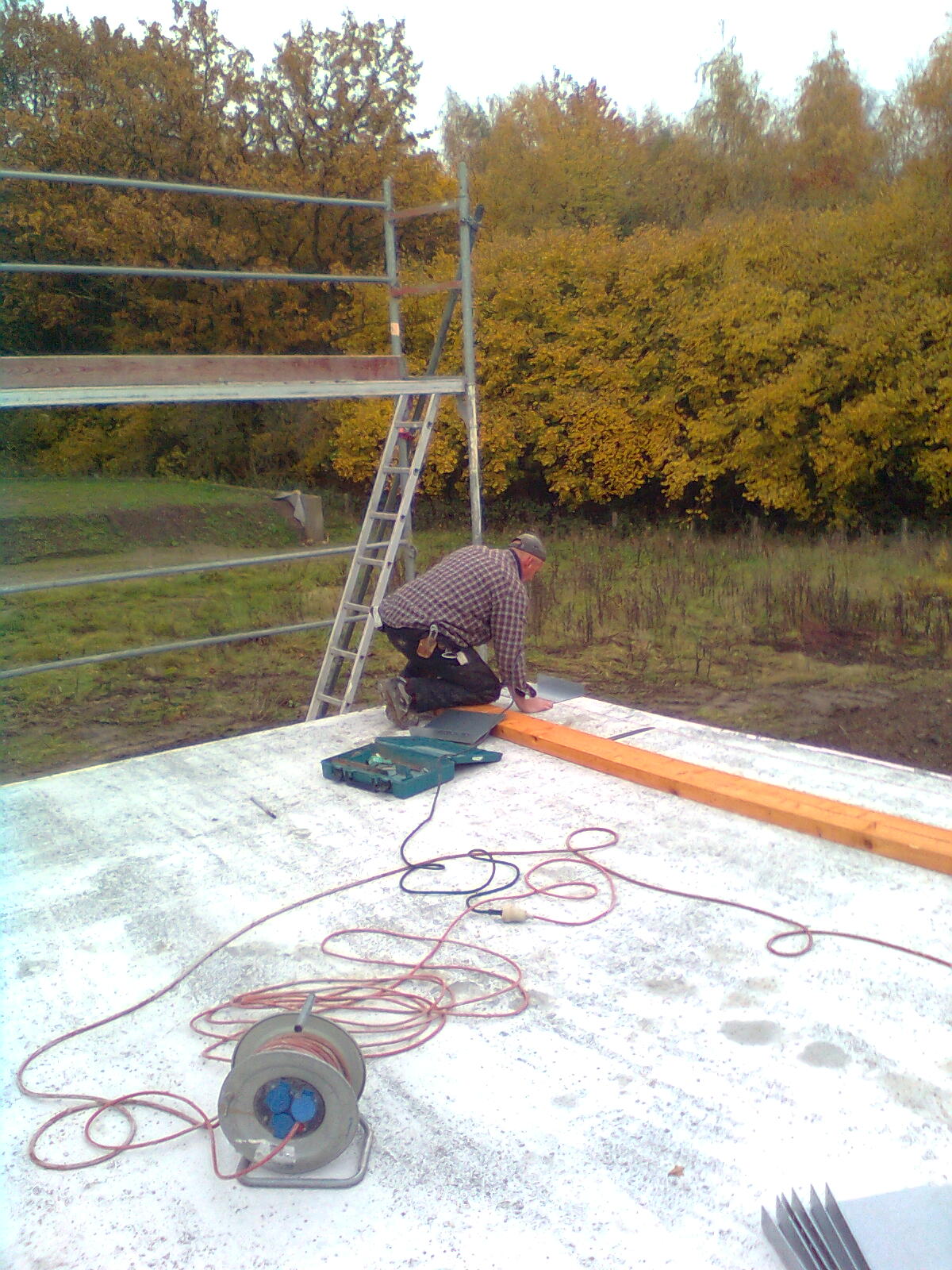

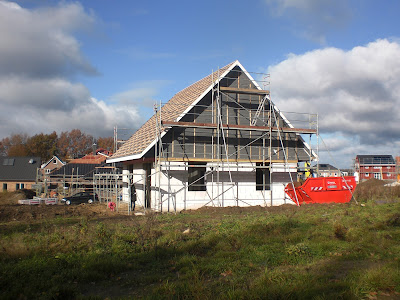

wow, this is really faster than expected. The roofer yesterday covered the entire roof, installed the skylight and installed our own anxious passage pan for the satellite dish. This is Braas and the same color as our roof tiles. We have them concerned with the local Building Materials, which were significantly cheaper than any provider in the I-Net (45, - €). The roof plumbers have also installed the gutters.

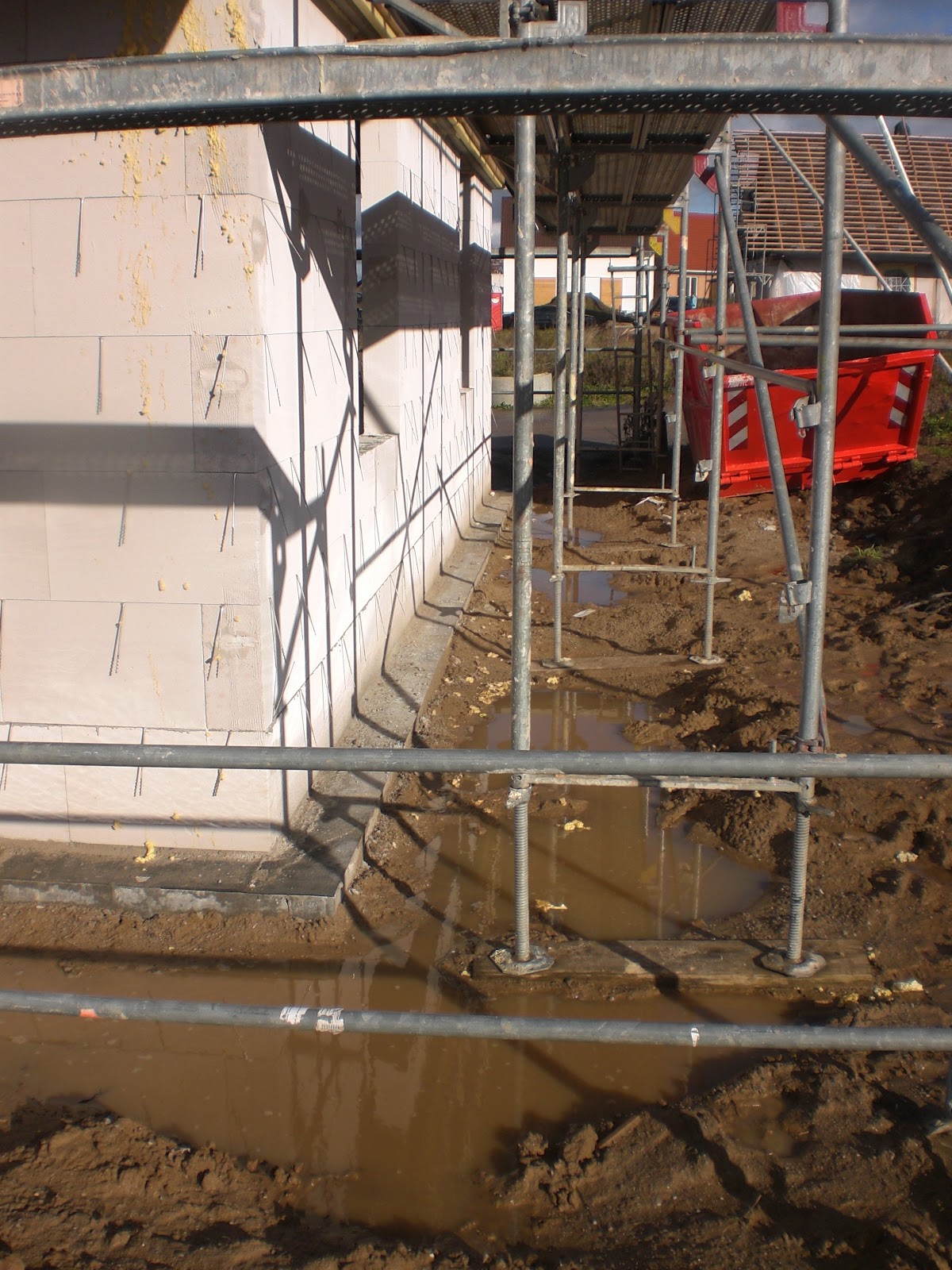

Our Maurer J & S also have been busy. The west side was completely blinded to floor height, our wall box for air dryer They have also installed the same. According to construction schedule is actually not until next week, starting with the Verblendarbeiten, it is us but also very right.

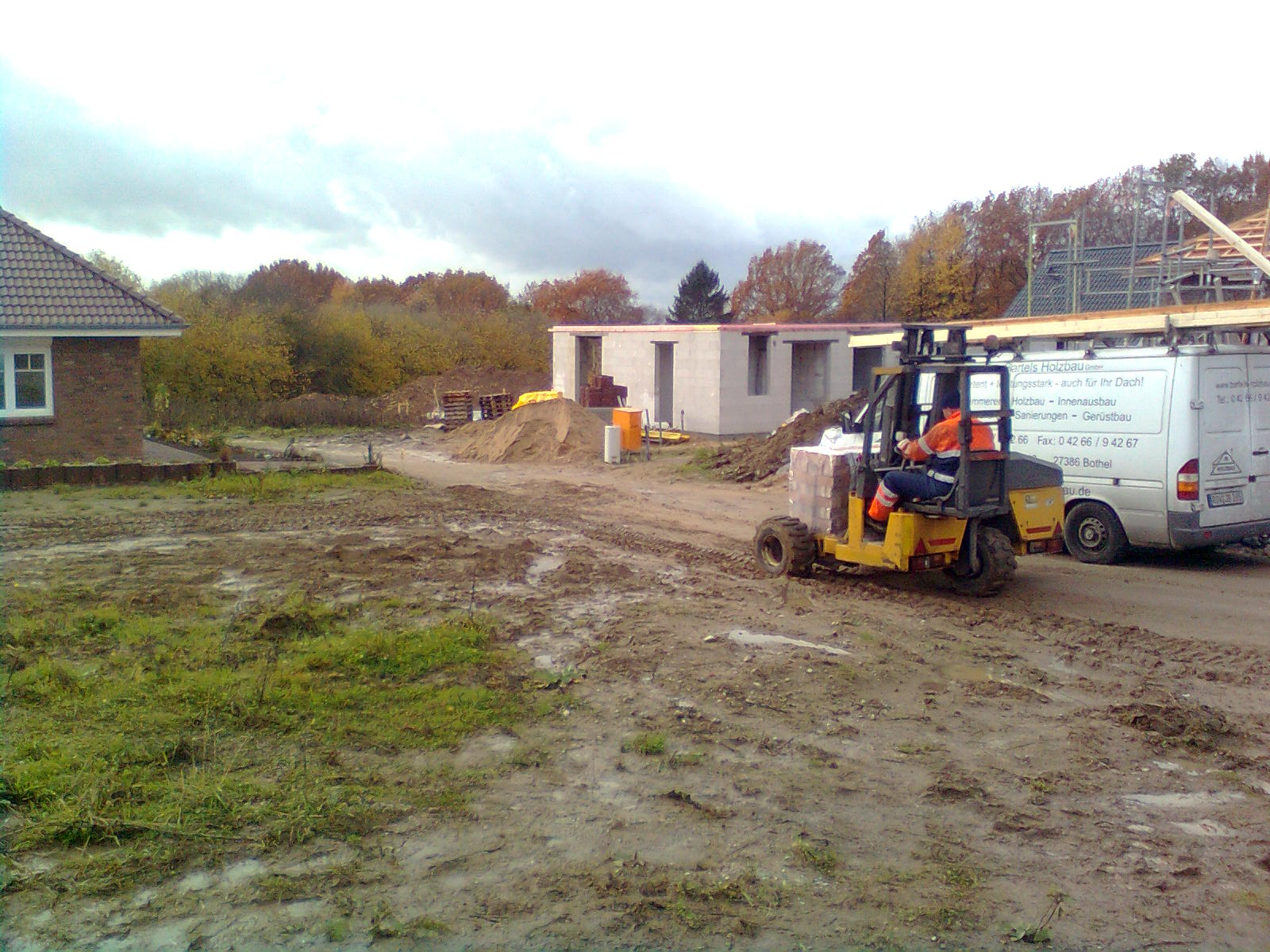

Am 11.11. the company is eco-Hus and will make the deep hole for the geothermal.
pictures I could not, unfortunately, it was already dark when I arrived at the site.
Hello readers,
wow, this is really faster than expected. The roofer yesterday covered the entire roof, installed the skylight and installed our own anxious passage pan for the satellite dish. This is Braas and the same color as our roof tiles. We have them concerned with the local Building Materials, which were significantly cheaper than any provider in the I-Net (45, - €). The roof plumbers have also installed the gutters.
Our Maurer J & S also have been busy. The west side was completely blinded to floor height, our wall box for air dryer They have also installed the same. According to construction schedule is actually not until next week, starting with the Verblendarbeiten, it is us but also very right.
Am 11.11. the company is eco-Hus and will make the deep hole for the geothermal.
pictures I could not, unfortunately, it was already dark when I arrived at the site.
Saturday, November 6, 2010
Can I Have Popcorn During Liver Infection?
Weekly Review (11/01 to 11/05..) - Picture Update
Hello readers,
as promised, there is the big weekly review. There are pictures later, that data cable I have forgotten in the office ...
first one we got last weekend, our construction schedule. If this can be met, we can in April 2011 in our house . Move It sounds to ever quite well. We then noticed that the borehole will come according to plan until November 2011 ... because what does not seem to be right. So: first called Mr. Koop and question if the so is quite correct. Here he has a mistake, is coordinated with the company Eco-Hus, that the probes will be drilled later this year. So all in butter!

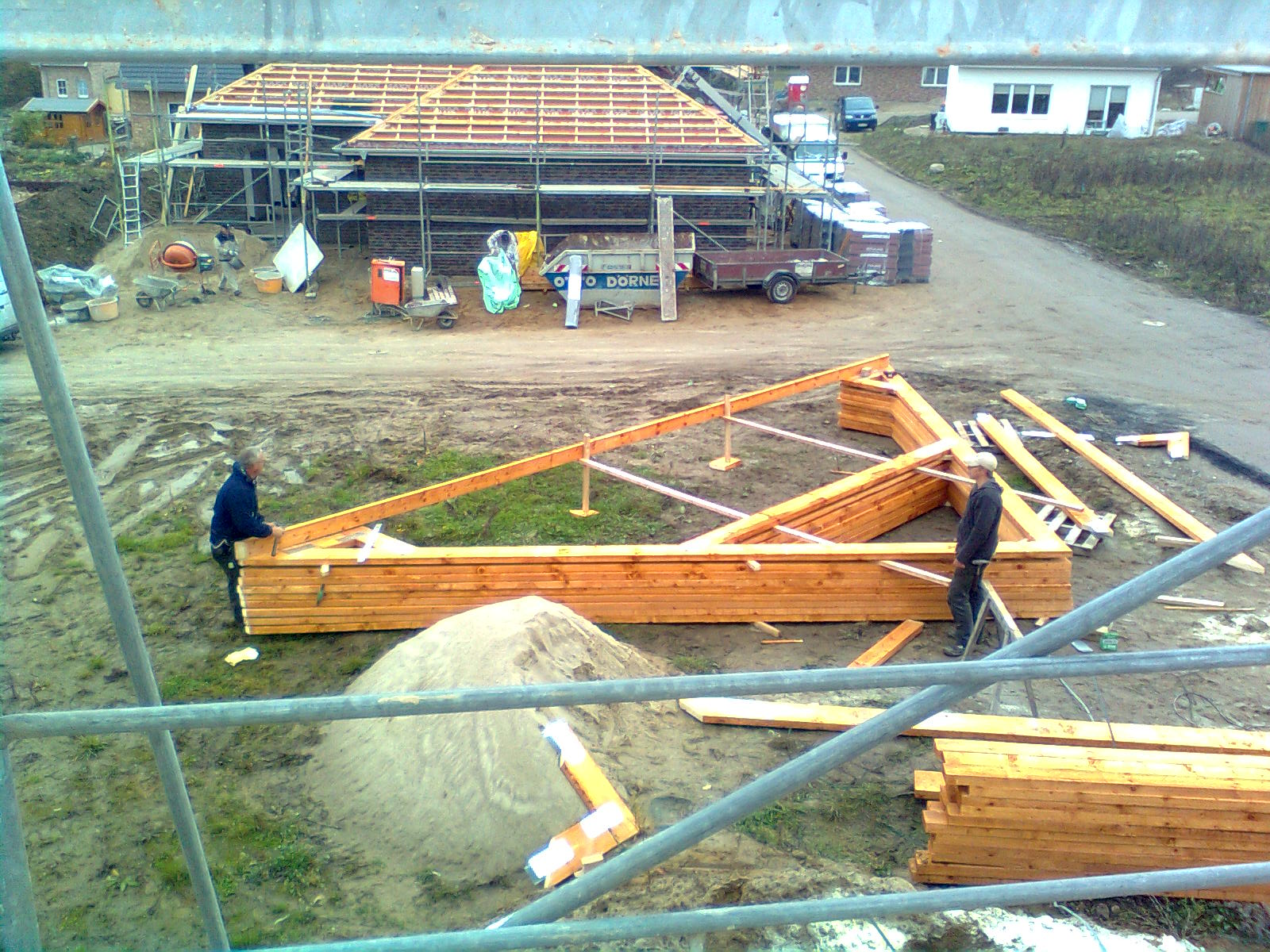

On Monday (01.11.) Began the carpentry Kruse, the elements of our roof on the adjacent land to build together. Well that is still unsold and undeveloped, otherwise there would have been a real space problem.

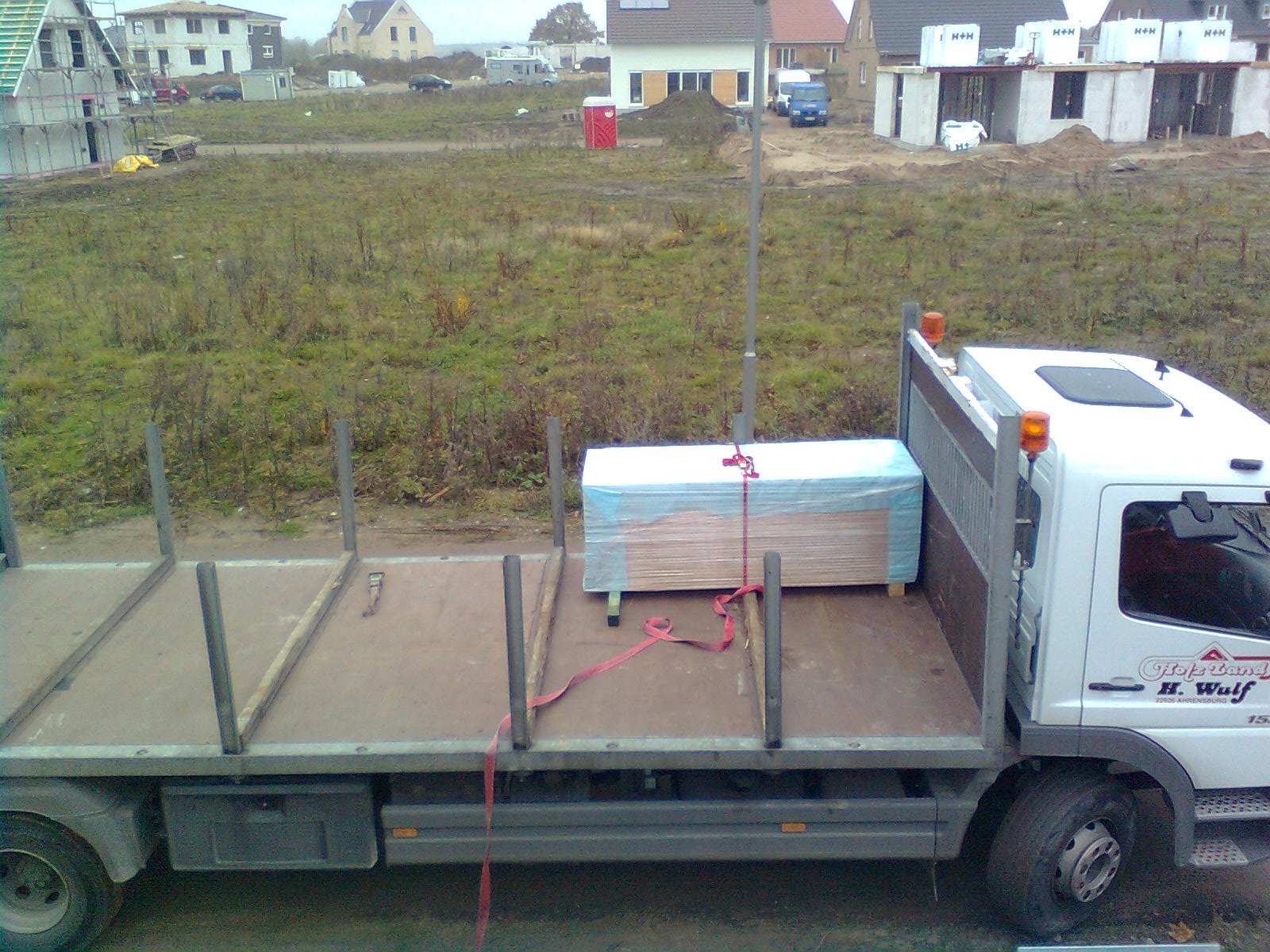

Relatively short, I decided to HolzLand Wulf in Ahrensburg 45m ² or 22mm OSB with N + F ordered for the expansion of the attic. The sqm price incl delivery was here at 9.36 €. A better price I could not make the quick find. The plates were delivered on Tuesday and the nice driver (also a Oldesloer), this set with its crane to the EC ceiling.

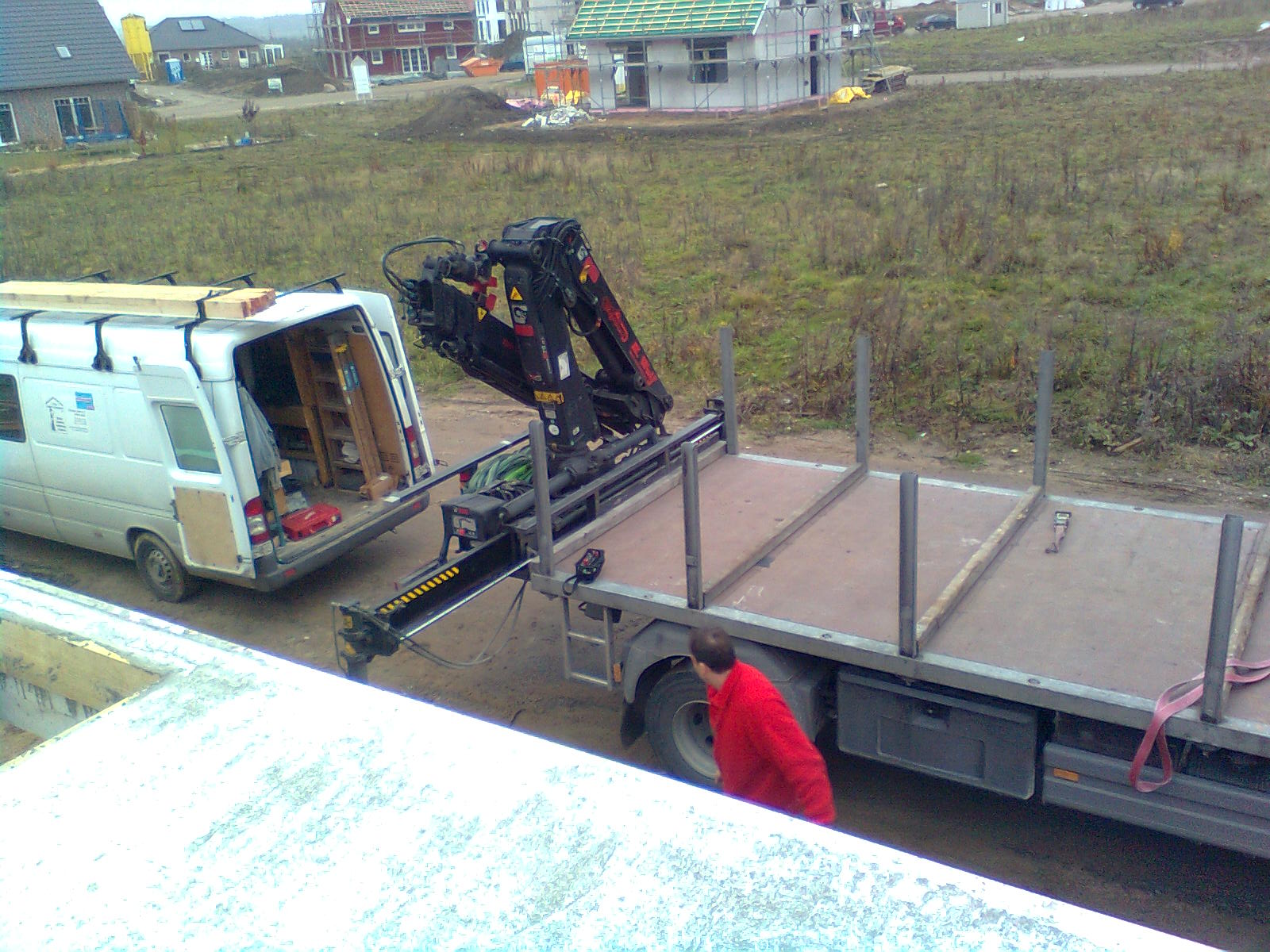

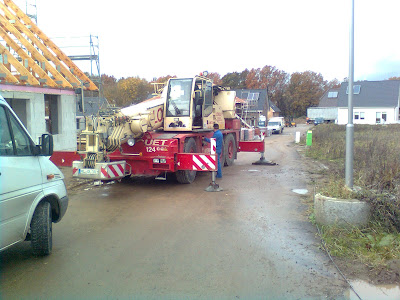

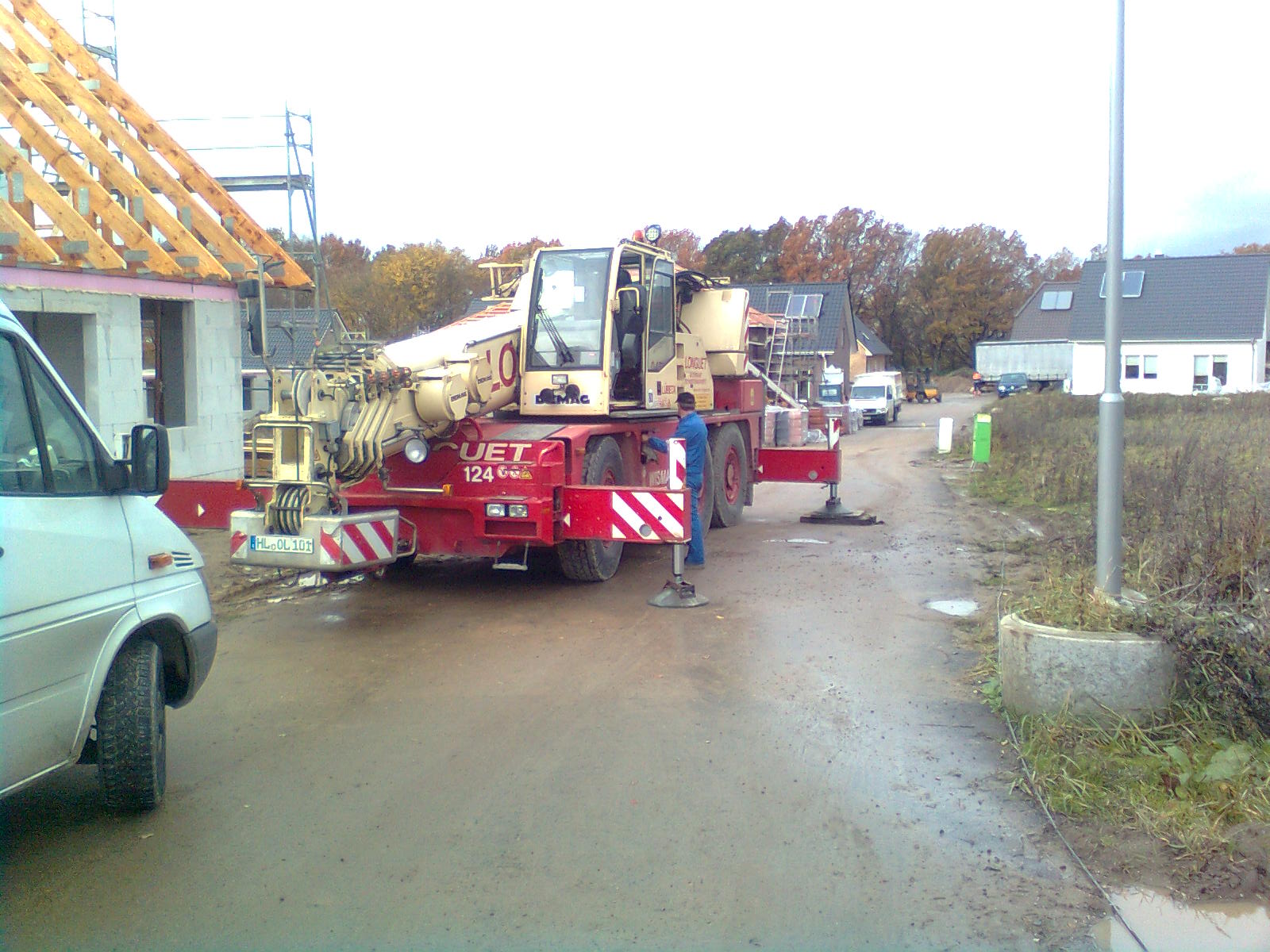

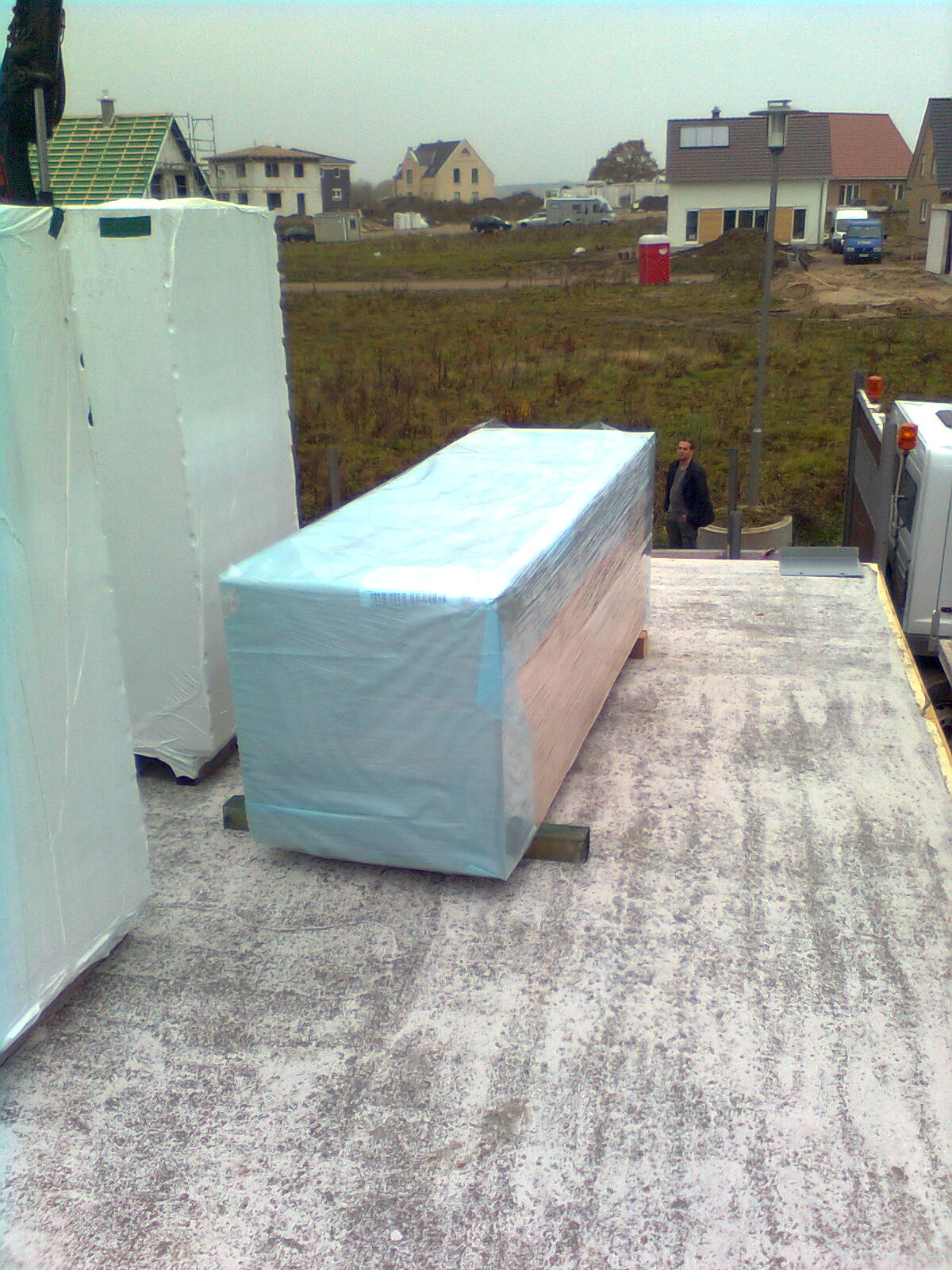

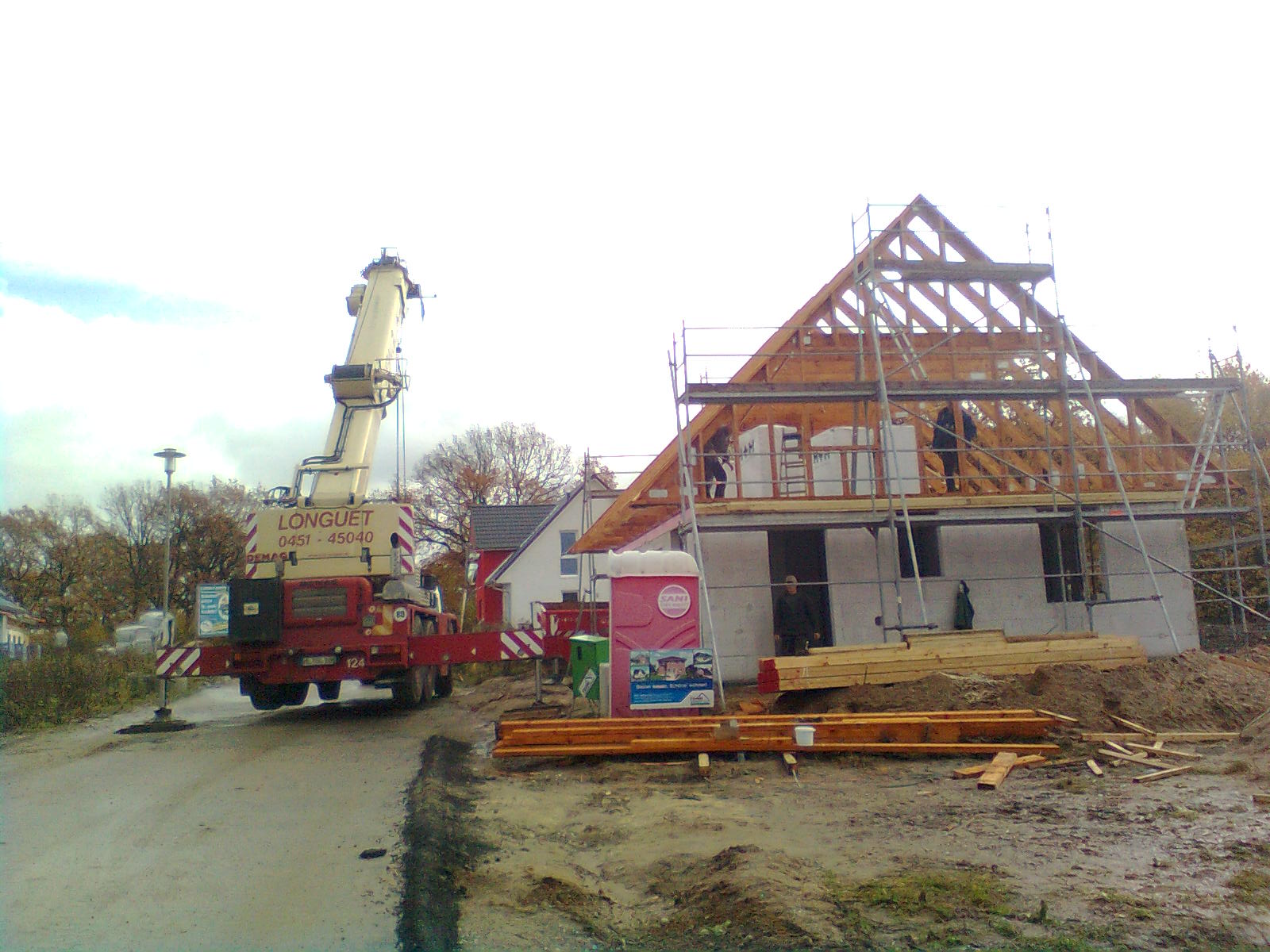

on Wednesday (03.11.) Should be coming to 09.00 of the crane for the construction of the roof. As the carpenters, the OSB with the crane would equate to in the attic, I have first issued a tasty breakfast with lots of coffee. That was a good thing that the weather was lousy and the portable crane was visible for miles around nothing. A quick call to the crane company then brought disillusionment: the crane is broken, replacement is on its way and should arrive around 12:00 on the site. Then I drove back home and wanted to be on site around 12:00. This time I did not miss the crane again. Around 11:30, I then get a call from a friend, our roof is under construction. So I quickly into the car and losgedüst and what I saw when I arrived on the site, the crane was being lowered again. The roof was installed, the OSB panels were in the attic and I have again seen a crane-Action ...
On Thursday and Friday, the carpenters will have the underlay and battens attached. The storm and rain no easy task. I had expected that they go home. But they were completely finished, good job! Meanwhile, the facing bricks and insulation were provided for the roof and placed on the neighboring property.
When we were again briefly on Friday at the site, the carpenters have just packed together. Coincidentally, the builders were there and have ever angschaut its terms of reference for the next few days.
Next week come the roofer and the plumber. The Masons are not planned until after next week. But since you have already looked and bricks and concrete mixers that are already, I have great hope that you will begin sooner. We will see ...
Here's a little picture update:
Hello readers,
as promised, there is the big weekly review. There are pictures later, that data cable I have forgotten in the office ...
first one we got last weekend, our construction schedule. If this can be met, we can in April 2011 in our house . Move It sounds to ever quite well. We then noticed that the borehole will come according to plan until November 2011 ... because what does not seem to be right. So: first called Mr. Koop and question if the so is quite correct. Here he has a mistake, is coordinated with the company Eco-Hus, that the probes will be drilled later this year. So all in butter!
On Monday (01.11.) Began the carpentry Kruse, the elements of our roof on the adjacent land to build together. Well that is still unsold and undeveloped, otherwise there would have been a real space problem.
Relatively short, I decided to HolzLand Wulf in Ahrensburg 45m ² or 22mm OSB with N + F ordered for the expansion of the attic. The sqm price incl delivery was here at 9.36 €. A better price I could not make the quick find. The plates were delivered on Tuesday and the nice driver (also a Oldesloer), this set with its crane to the EC ceiling.
on Wednesday (03.11.) Should be coming to 09.00 of the crane for the construction of the roof. As the carpenters, the OSB with the crane would equate to in the attic, I have first issued a tasty breakfast with lots of coffee. That was a good thing that the weather was lousy and the portable crane was visible for miles around nothing. A quick call to the crane company then brought disillusionment: the crane is broken, replacement is on its way and should arrive around 12:00 on the site. Then I drove back home and wanted to be on site around 12:00. This time I did not miss the crane again. Around 11:30, I then get a call from a friend, our roof is under construction. So I quickly into the car and losgedüst and what I saw when I arrived on the site, the crane was being lowered again. The roof was installed, the OSB panels were in the attic and I have again seen a crane-Action ...
On Thursday and Friday, the carpenters will have the underlay and battens attached. The storm and rain no easy task. I had expected that they go home. But they were completely finished, good job! Meanwhile, the facing bricks and insulation were provided for the roof and placed on the neighboring property.
When we were again briefly on Friday at the site, the carpenters have just packed together. Coincidentally, the builders were there and have ever angschaut its terms of reference for the next few days.
| |
| view East |
Next week come the roofer and the plumber. The Masons are not planned until after next week. But since you have already looked and bricks and concrete mixers that are already, I have great hope that you will begin sooner. We will see ...
Here's a little picture update:
| |

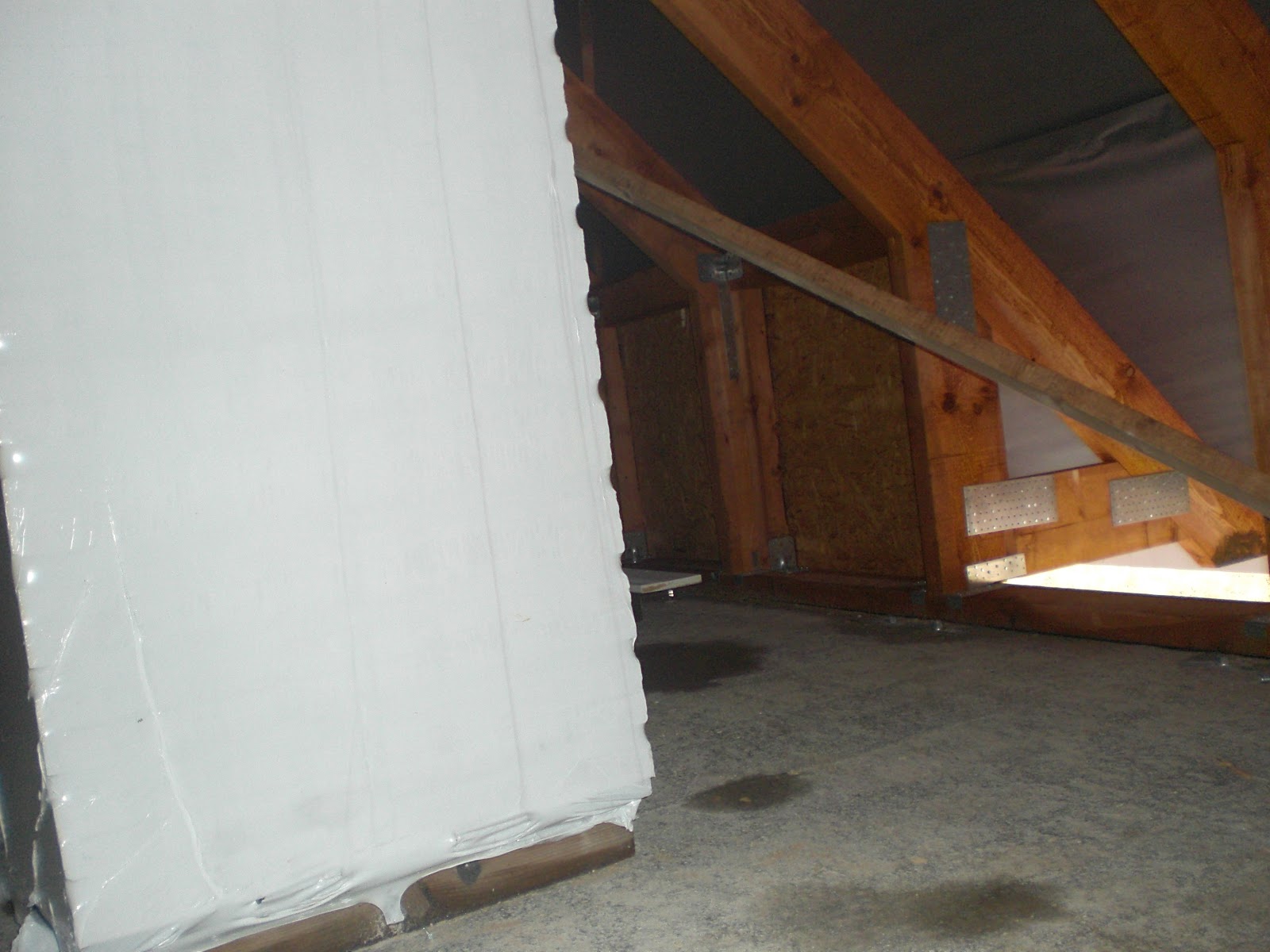

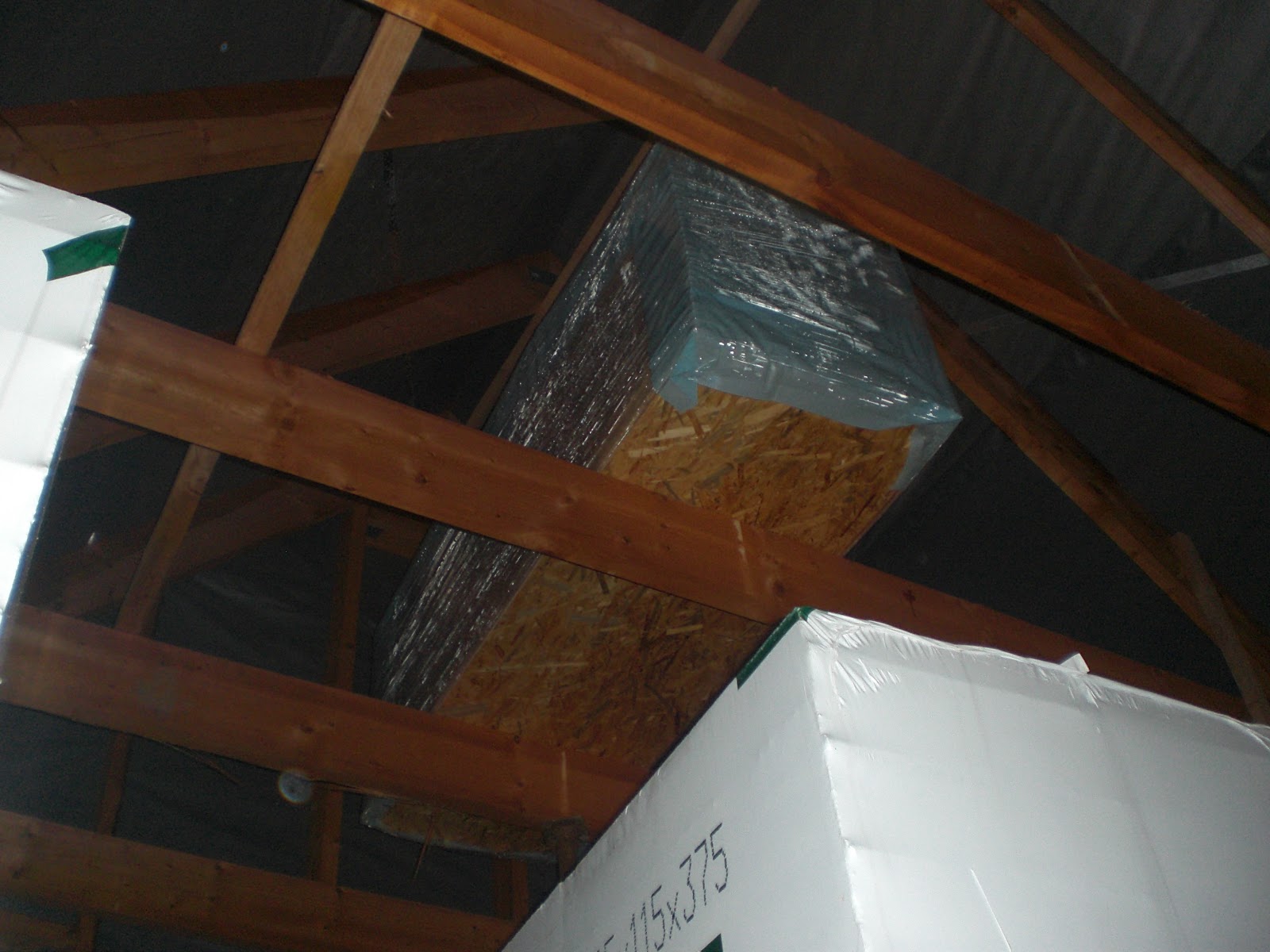

| OSB boards in the attic |
| |
| Bracing strip |
| | |
| Our moat |
Wednesday, November 3, 2010
Bleeding After A Brazilian Wax
Much has happened ...
Hello readers,
the last few days a lot has happened. Meanwhile, the roof and directed the facing bricks have also been delivered already. The construction schedule has arrived and we have a momentum OSB (45m ²) bought for the loft conversion.
the moment I have unfortunately not so much time to blog. is a major update to the latest at the weekend, I promise!
Hello readers,
the last few days a lot has happened. Meanwhile, the roof and directed the facing bricks have also been delivered already. The construction schedule has arrived and we have a momentum OSB (45m ²) bought for the loft conversion.
the moment I have unfortunately not so much time to blog. is a major update to the latest at the weekend, I promise!
